Home Remodel Timeline Northern Virginia: 2026 Guide

Home remodel timeline Northern Virginia: family reviewing renovation plans with a design-build team

A realistic home remodel timeline Northern Virginia homeowners can plan around starts with one fact: most projects take longer to plan than to build. A bathroom remodel can finish in 3 to 6 weeks. A kitchen runs 4 to 20 weeks depending on scope. A home addition takes 5 to 11 months from first design meeting to final inspection. A full gut renovation can stretch to 18 months.

At US Home Design Build, our design-build team in McLean has managed kitchen, bathroom, addition and whole-home projects for homeowners across Northern Virginia, including Fairfax County, Vienna, Reston, Great Falls and Burke. The schedules below draw on those projects, on Fairfax County and Arlington County permitting information, and on national research.

Treat every number here as a range, not a promise. Your home’s age, your selections and your jurisdiction move the dates. This guide shows what drives each phase so you can spot a realistic schedule and a rushed one.

How Long Does a Home Remodel Take in Northern Virginia?

Most Northern Virginia remodels take from 3 weeks to 18 months, depending on scope. Bathrooms run about 3 to 6 weeks, kitchens 4 to 20 weeks, additions 5 to 11 months, and whole-home renovations 3 to 18 months. These figures measure different windows, so any home remodel timeline Northern Virginia contractors quote should say whether it means construction only or start to finish.

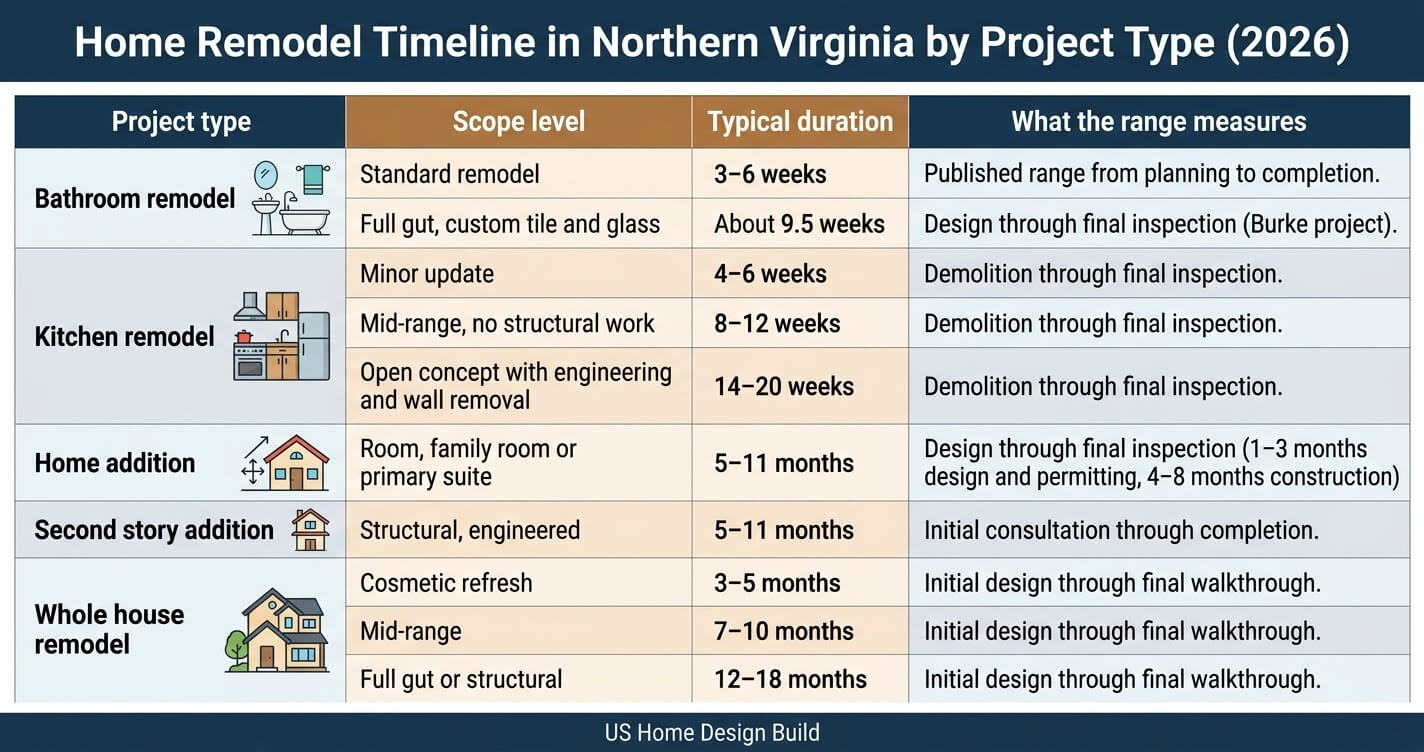

Table 1: Home Remodel Timeline in Northern Virginia by Project Type (2026)

Home remodel timeline Northern Virginia by project type: bathroom, kitchen, addition and whole house durations

US Home Design Build guides on bathroom remodel cost in Northern Virginia, bathroom remodel before and after in Burke VA, kitchen remodeling in Vienna VA, questions to ask before hiring a home addition contractor, second story addition in Northern Virginia  and whole house remodel in Northern Virginia.

Why do the published ranges differ? Some start the clock at demolition. Others start at the first consultation. A kitchen that takes 12 weeks on site can still take 9 months from first sketch to final inspection once design, selections and permits are counted. That gap is the most common source of missed expectations in any home remodel timeline Northern Virginia homeowners receive from a contractor.

Ground-up builds follow a different schedule. Homeowners weighing a new home should read our custom home build timeline for Northern Virginia, which covers 12 to 18 months from consultation to move-in.

Why Does Planning Take Longer Than Construction?

Planning usually takes longer than building. National survey data shows kitchen projects average 9.5 months of planning and 5.8 months of construction. In Northern Virginia, layout decisions, engineering, permit drawings and material selections fill that planning window.

The 2026 Houzz & Home Study, a national survey of renovating homeowners published by Houzz, found that kitchen projects average 9.5 months of planning and 5.8 months of construction. The same study found the pattern holds for smaller rooms: closets averaged 6.6 months of planning against 4.3 months of construction, and home offices averaged 6.1 months against 3.4 months. Planning outlasts building in every category it reported.

Three tasks consume most of that time in our market:

  • Layout and scope decisions. Moving a wall, a sink or a stair changes the engineering and the permit drawings.
  • Selections. Tile, cabinetry, windows and fixtures each carry an order date. A late choice delays every trade behind it.
  • Approvals. Permit review, and where relevant homeowner association review, must finish before crews start.

Design-build can shorten this stage. When one team handles design and construction, design and pre-construction planning overlap instead of running in sequence. Our design-build guide for Northern Virginia explains how that overlap works and where it helps most.

What Are the Phases of a Northern Virginia Home Remodel?

Every remodel moves through six phases: discovery, design and selections, permitting, procurement, construction, and inspections with closeout. Permitting and procurement should overlap. Construction is only one of the six clocks in a home remodel timeline Northern Virginia homeowners should plan around.

Table 2: Six Phases of a Northern Virginia Home Remodel and How Long Each Takes

Six phases of a Northern Virginia home remodel timeline from discovery to closeout

Experienced teams do not treat permitting as idle waiting time. While the county reviews drawings, they finalize selections, confirm subcontractors and place orders. That overlap is where a design-build team recovers weeks. It is also why a contractor should explain each phase separately rather than quote one combined number, a point we cover in our guide to choosing a home renovation contractor in Northern Virginia.

How Long Do Permits Take in Fairfax County and Arlington?

Fairfax County reported in June 2026 that decks clear review in 2 to 3 business days, fast-track residential projects in about 2, and major additions in about 13 business days. Arlington County processes additions and renovations through its ePlan portal. Always confirm current times on the county’s live pages before you set a start date.

Contractor reviewing Fairfax County remodeling permit plans for a Northern Virginia home remodel timeline

Fairfax County Land Development Services (LDS) has cut residential review times, according to a June 2026 report on Springfield District Supervisor Pat Herrity’s community newsletter. The report states that deck applications are reviewed in two to three business days, fast-track residential projects in as little as two business days, and larger projects such as major additions and new homes in about thirteen business days. Infill lot grading plans take about nineteen business days. These figures change, and LDS publishes weekly review metrics at Fairfax County Plan2Build.

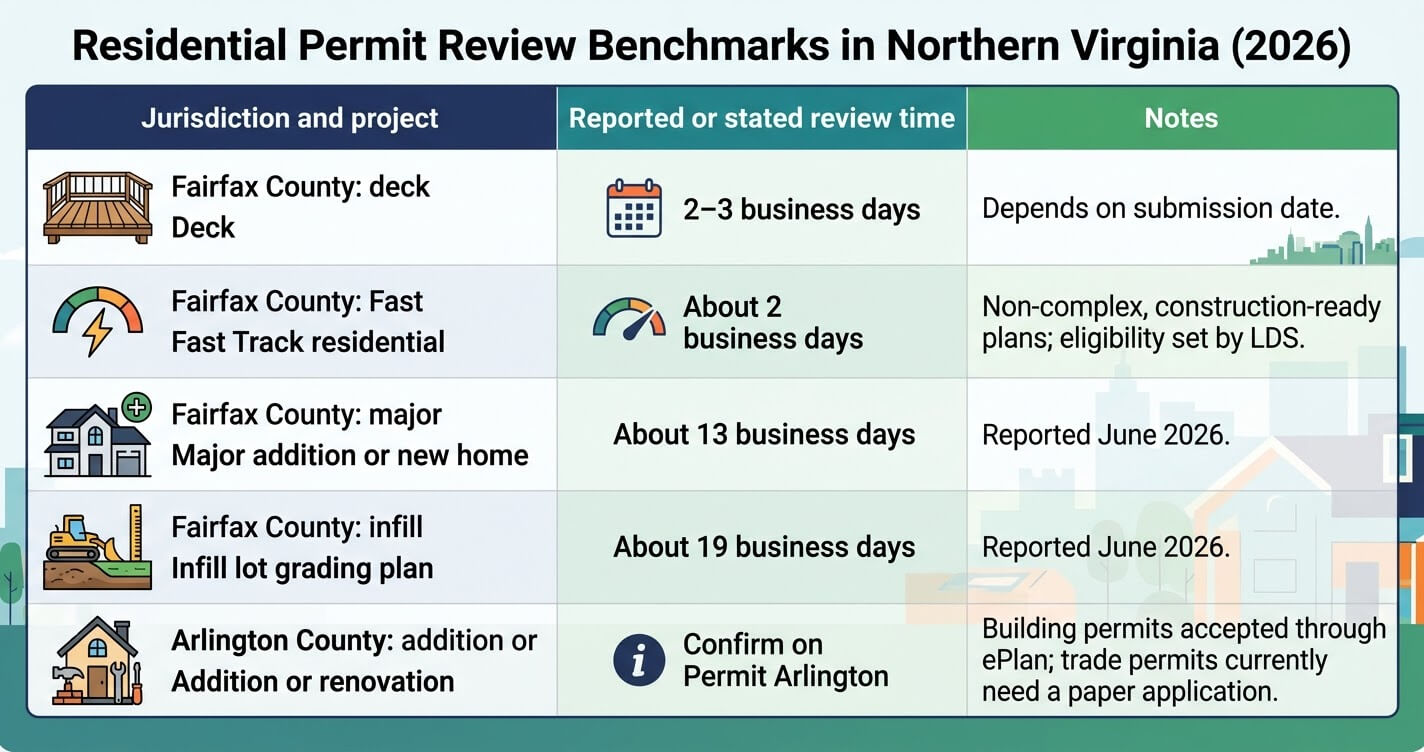

Table 3: Residential Permit Review Benchmarks in Northern Virginia (2026)

Fairfax County remodeling permit review times for decks, additions and grading plans in 2026

Fairfax County’s Fast Track program gives priority review to non-complex residential work. Fairfax County LDS lists decks, finished basements and small additions up to 500 square feet as examples, and it advises applicants to contact staff to confirm eligibility before submitting. Fast Track can move a small project weeks ahead of a standard review.

Arlington County requires a building permit for additions, alterations and work that modifies walls or fixtures. Arlington accepts electronic plan submission for building permits on additions and renovations, while trade permits currently require a paper application. We did not find a published Arlington review time, so ask your contractor for the current figure.

Northern Virginia is not governed by one permitting office. Fairfax County, Arlington County and independent cities such as Alexandria, Falls Church and the City of Fairfax run separate processes. Our local guides walk through each: remodeling permits in Fairfax County and home renovation permits in Arlington VA.

Faster county reviews change where schedule risk sits. Reviews that once took weeks can now finish in days, so incomplete drawings, correction cycles and material lead times decide more of the home remodel timeline Northern Virginia projects follow. A complete first submission is the cheapest way to save time.

Which Material Lead Times Control Your Schedule?

Long-lead materials, not carpentry, often set the finish date. Custom vanities can take 6 weeks, windows and doors from domestic manufacturers 10 to 14 weeks or more, and stone fabrication about 9 days after templating. Order during permit review so materials arrive when crews are ready.

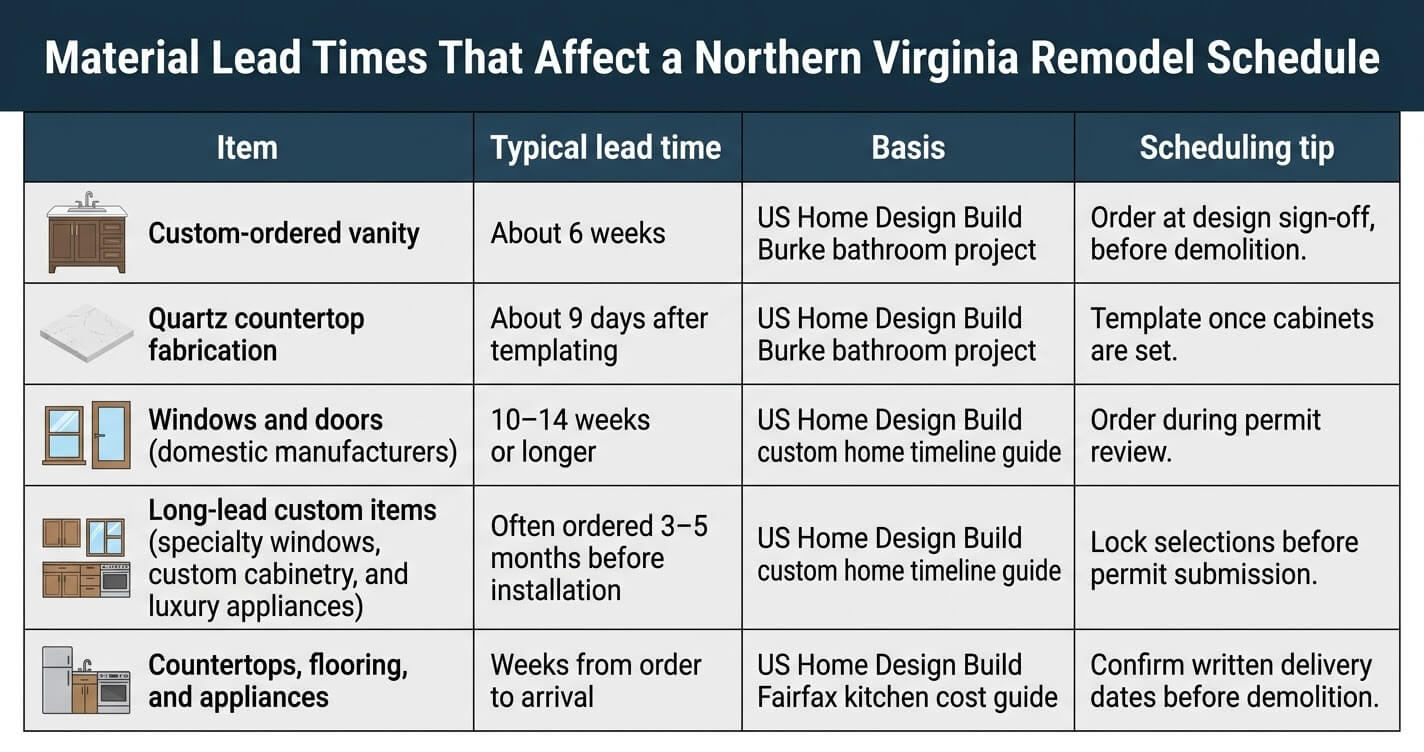

Table 4: Material Lead Times That Affect a Northern Virginia Remodel Schedule

Material lead times affecting a Northern Virginia home remodel timeline: vanity, quartz and windows

Late changes cost more than money. Swapping a selected material after the order is placed can reset a lead time and, if the change alters the approved plans, trigger re-permitting. Homeowners who lock selections before construction starts typically stay closest to the original schedule, as our whole house remodel guide explains.

Homeowners considering a similar project may benefit from discussing their options with an experienced design-build team before finalizing budgets or timelines. A written schedule that shows permit review, ordering dates and construction windows separately makes any home remodel timeline Northern Virginia contractors quote easier to compare.

What Causes Remodeling Delays in Northern Virginia Homes?

Five causes account for most delays: incomplete permit submissions, mid-project scope changes, long material lead times, hidden conditions in older homes, and inspection or approval scheduling. Most are preventable with early decisions and a complete first permit package, which keeps your home remodel timeline Northern Virginia projects depend on intact.

Older housing stock makes hidden conditions likely. The National Association of Home Builders (NAHB), analyzing American Community Survey data, reports that the median age of owner-occupied homes in the United States reached 42 years in 2024, up from 31 years in 2005. NAHB also reports that homes at least 45 years old rose from 39 percent of owner-occupied stock in 2014 to 47 percent in 2024. Many Northern Virginia neighborhoods skew older still, which is why demolition day can reveal wiring, framing or plumbing that no drawing showed.

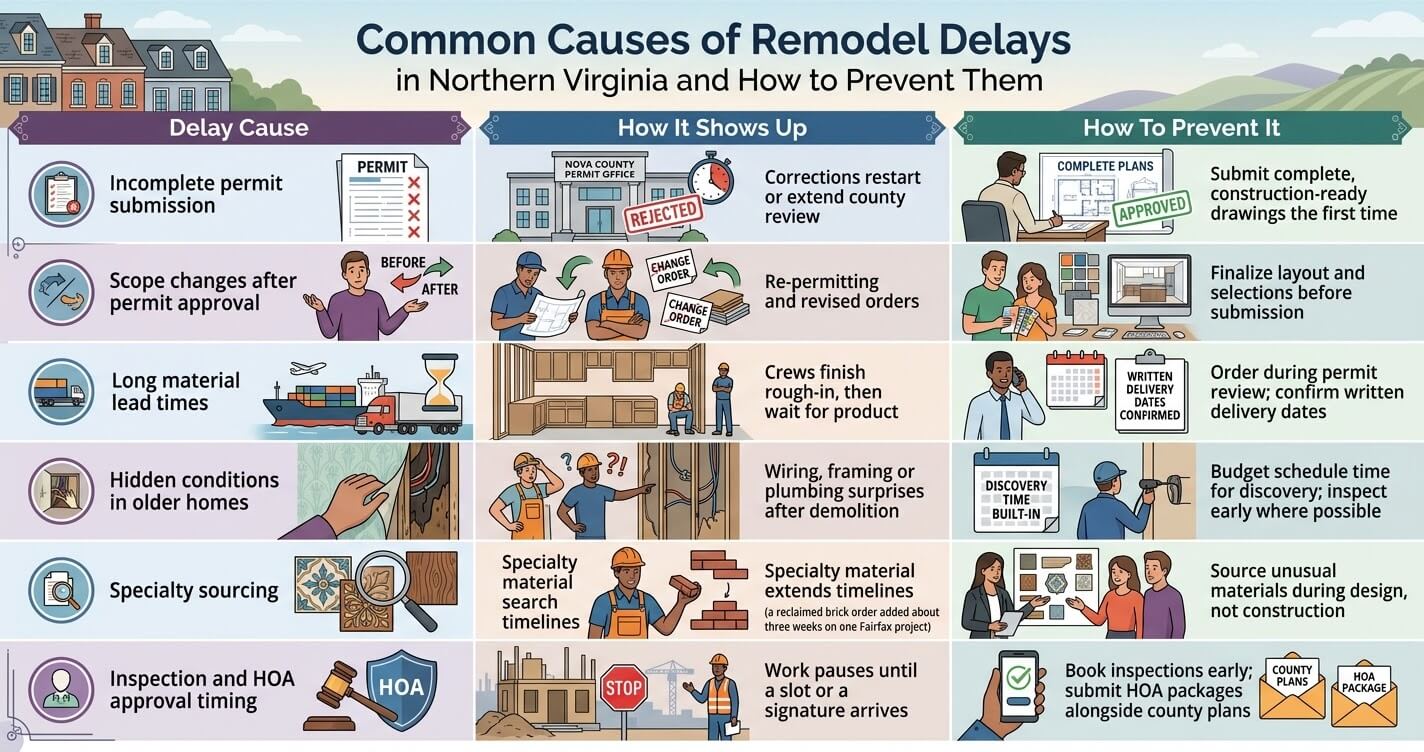

Table 5: Common Causes of Remodel Delays in Northern Virginia and How to Prevent Them

Common causes of remodeling delays in Northern Virginia and how to prevent them

Inspection availability matters more than most homeowners expect. Fairfax County LDS publishes a two-week view of open building inspection slots, and a day with no open slots means no inspections that day. A contractor who books inspections as soon as work is ready protects the schedule.

Homeowners in 1970s houses should plan for extra discovery time. Our guide to a 1970s Colonial remodel in Northern Virginia covers what typically surfaces in that era of construction.

What Did Three Northern Virginia Projects Actually Take?

Real projects land inside the published ranges. A 960-square-foot McLean addition took 38 weeks, a full home renovation in Vienna took 8 months, and a full-gut bathroom in Burke took about 9.5 weeks. Permit review and long-lead materials shaped each schedule.

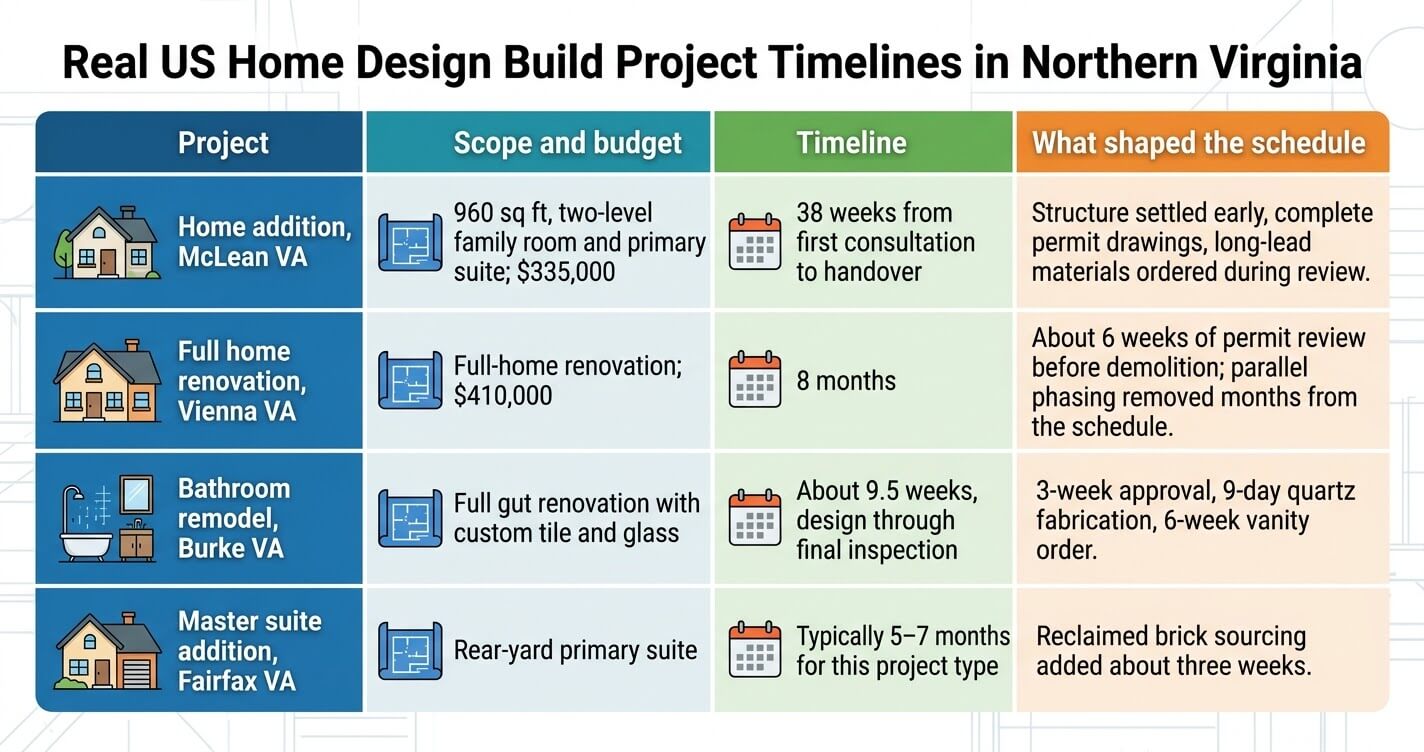

Table 6: Real US Home Design Build Project Timelines in Northern Virginia

Real remodel timelines in McLean, Vienna and Burke VA from US Home Design Build

One scheduling choice stands out. On the Vienna project, deciding which phases run in parallel and which run in sequence can add or remove two to three months. Finishing the basement alongside the main floors, rather than last, protected the timeline. Ask any contractor which of your phases will overlap.

Should You Live in Your Home During a Remodel?

Most bathroom and kitchen remodels are livable with a temporary setup. Whole-home renovations and large additions often justify moving out or phasing the work by floor. The choice changes the schedule, the cost and daily stress.

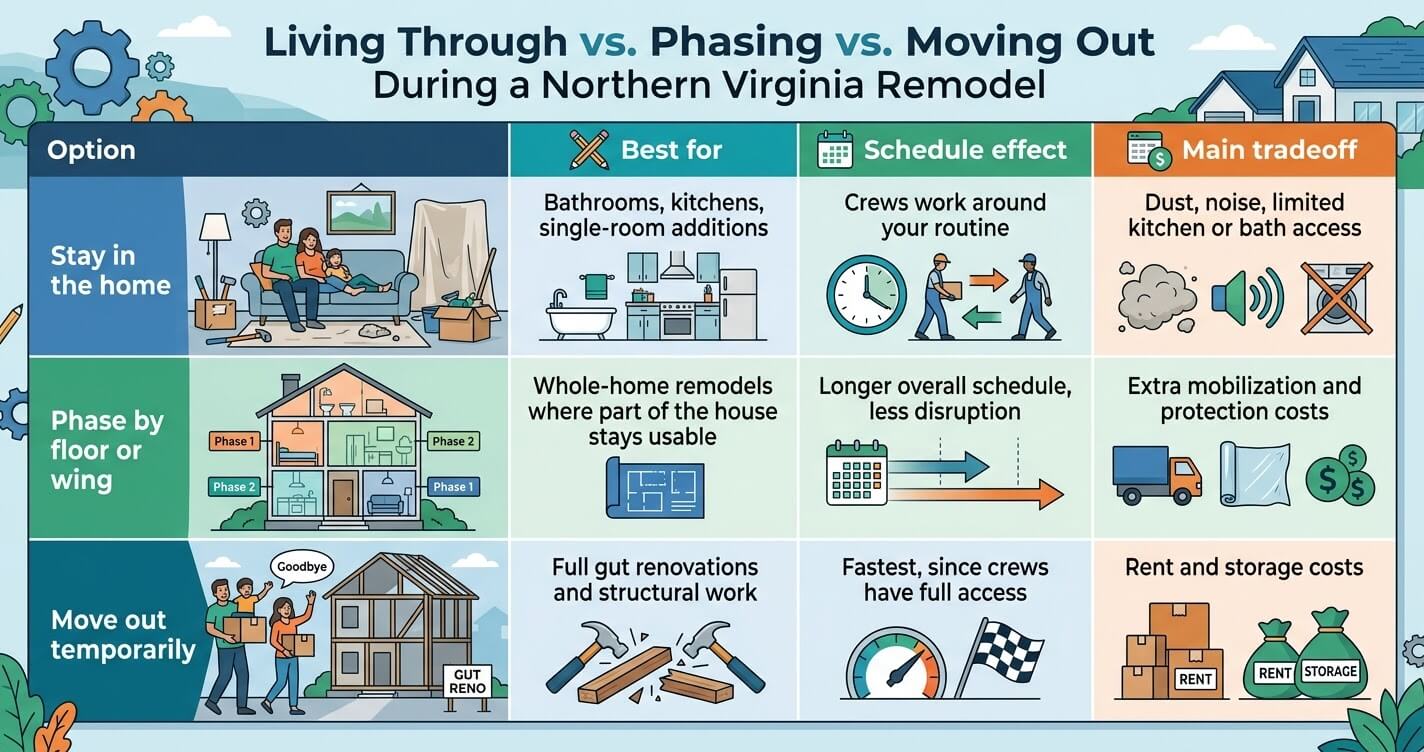

Table 7: Living-Through vs. Phasing vs. Moving Out During a Northern Virginia Remodel

Living in your home during a Northern Virginia remodel: stay, phase or move out compared

Check your insurance before crews arrive. Coverage during construction is not automatic, and our guide to home renovation insurance in Northern Virginia explains what to confirm with your carrier and contractor.

How Do You Build a Realistic Remodel Schedule?

Build the schedule from six separate clocks, add a buffer of roughly 10 to 15 percent, and lock selections before permit submission. A home remodel timeline Northern Virginia contractors present with one combined number and no phase detail is a warning sign.

Contractor and homeowner reviewing a home remodel timeline Northern Virginia schedule on site

Use this checklist before you sign a contract:

  • Get phases in writing. Design, permitting, procurement, construction and closeout should each have a start and end window.
  • Confirm what the timeline measures. Ask whether it starts at demolition or at your first meeting.
  • Ask about overlap. Which orders are placed during permit review? Which trades run in parallel?
  • Add a buffer. In our experience with older Northern Virginia homes, 10 to 15 percent of the schedule is a practical planning cushion.
  • Confirm your jurisdiction. Fairfax County, Arlington County and the independent cities each have their own process.
  • Decide before you build. Every change after permit approval costs time and, often, money.

Two more resources help. Our kitchen remodeling service page and bathroom remodeling service page describe our process for those projects, and our home renovation service page covers larger scopes. For structural projects, see our home additions service and second story addition service.

Frequently Asked Questions

How long does a home remodel take in Northern Virginia?

Most projects take between 3 weeks and 18 months, depending on scope. A bathroom runs about 3 to 6 weeks, a kitchen 4 to 20 weeks, an addition 5 to 11 months and a full gut renovation 12 to 18 months. Any home remodel timeline Northern Virginia contractors quote should separate design, permitting, procurement and construction. See Table 1 for the full breakdown.

How long does a Fairfax County building permit take for a remodel?

It depends on the project. Fairfax County reported in June 2026 that decks clear in 2 to 3 business days, fast-track residential projects in about 2, and major additions in about 13 business days. Check the live figures on Fairfax County Plan2Build because they change weekly, and read our guide to remodeling permits in Fairfax County.

How long does a bathroom remodel take in Northern Virginia?

A standard bathroom remodel takes about 3 to 6 weeks. A full gut with custom tile and glass can take closer to 9.5 weeks from design through final inspection, as our Burke project did. Long-lead vanities and stone fabrication are the usual pacing items. See our bathroom remodel cost guide for pricing and process.

How long does a home addition take in Fairfax County?

Most Northern Virginia additions take 5 to 11 months from design through final inspection. That includes 1 to 3 months of design and permitting and 4 to 8 months of construction. Second-story and structurally complex additions sit at the longer end. Read our questions to ask before hiring a home addition contractor guide for a full timeline.

Why do remodels take longer than quoted?

Usually because the quote measured construction only, or because the plan changed after work began. The most common causes are incomplete permit packages, scope changes that require re-permitting, long material lead times and hidden conditions in older homes. Table 5 lists each cause and its fix.

What is the best time of year to start a remodel in Northern Virginia?

Late fall or winter is a strong time to start design and permitting, so construction can begin in spring. Interior projects such as kitchens and bathrooms can run year-round, while additions and exterior work depend more on weather. Starting design early also gives long-lead materials time to arrive.

Can I live in my house during a remodel?

Yes for most bathroom and kitchen projects, usually with a temporary setup. Whole-home renovations and large additions often work better with a phased plan or a temporary move. Table 7 compares the options, and our guide to home renovation insurance in Northern Virginia explains what to confirm with your carrier.

Conclusion: Plan the Clocks, Not Just the Calendar

A trustworthy home remodel timeline Northern Virginia homeowners can rely on separates six clocks: discovery, design, permitting, procurement, construction and closeout. Bathrooms and kitchens finish in weeks. Additions take 5 to 11 months. Whole-home renovations can reach 18 months. Fairfax County’s faster 2026 permit reviews help, but complete drawings, early orders and firm selections still decide whether a project finishes on time.

Our design-build team has seen these patterns across McLean, Vienna, Burke and Fairfax County. The projects that finish closest to plan settle scope early, submit complete permit packages, order long-lead materials during review, and hold a realistic buffer.

Planning a similar project in Northern Virginia? Contact US Home Design Build to discuss your goals, budget, and timeline with our team. Call (703) 202-3520 or visit us at 8200 Greensboro Dr Suite 900, McLean, VA 22102.
