This deck addition before and after Vienna VA case study documents a real composite deck project completed by US Home Design Build, in which a deteriorating wood deck was replaced with a low-maintenance composite structure in roughly eight weeks. The transformation addressed safety issues, expanded usable outdoor space, and gave the homeowner a resale-ready backyard.
With more than a decade of design-build experience across Northern Virginia, our team has walked dozens of homeowners through exactly this decision: repair an aging wood deck one more time, or replace it with composite decking built to last. This case study walks through the actual project scope, the design decisions, the Fairfax County permit process, the budget, the construction timeline, and the finished result.
Project Overview – What This Vienna VA Deck Addition Involved
This Vienna, VA deck addition involved removing an aging 14-by-16-foot wood deck attached to a 1990s Colonial-style home and replacing it with a 320-square-foot, two-tier composite deck. The scope included new footings, reframed structural support, composite decking boards, aluminum railings, and a redesigned stair layout connecting to the backyard.
The home sits on a moderately sloped lot, a common condition throughout Vienna, VA neighborhoods, which is part of why the original deck had settled unevenly over nearly two decades. Our deck builder in Northern Virginia team evaluated the existing footings, ledger board attachment, and framing before designing the replacement, since a sloped lot changes how footings and support posts need to be engineered for long-term stability.
The Homeowner’s Challenge – Why the Old Deck No Longer Worked

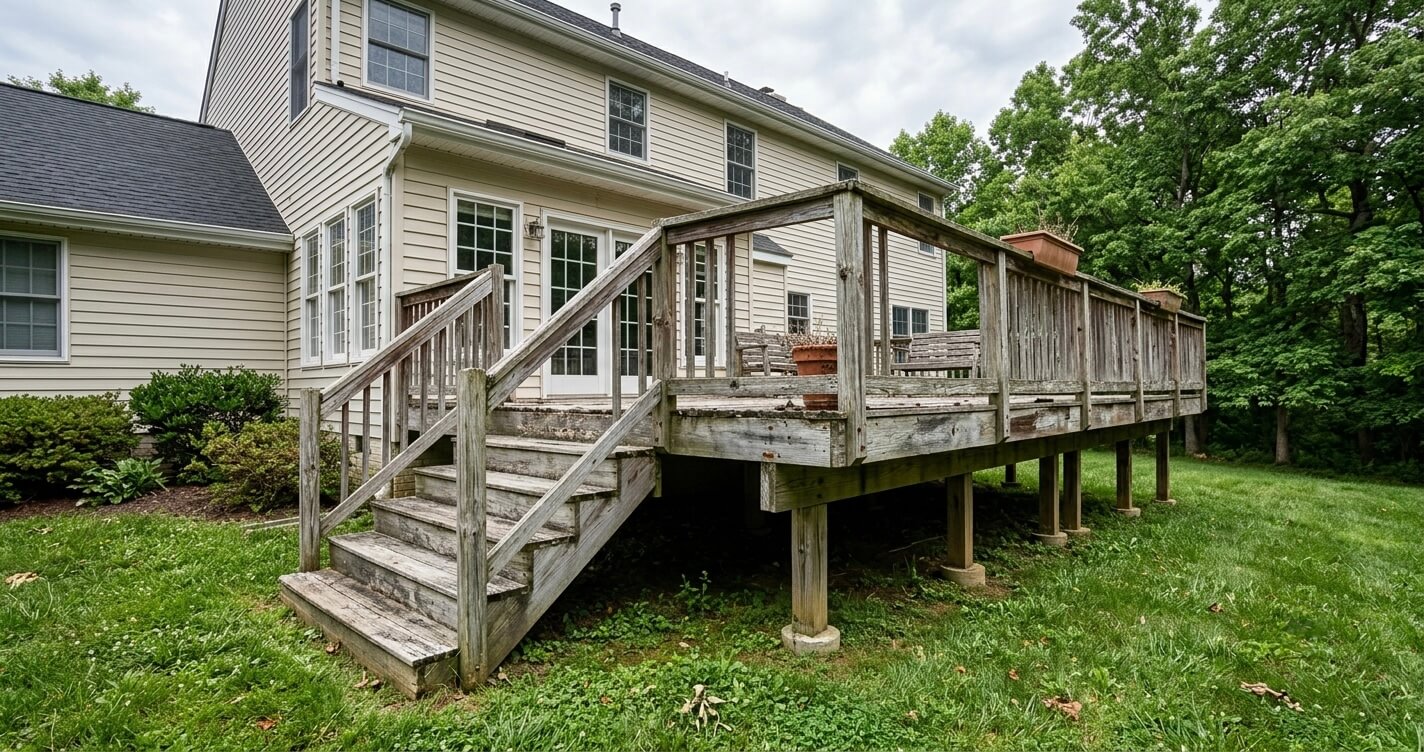

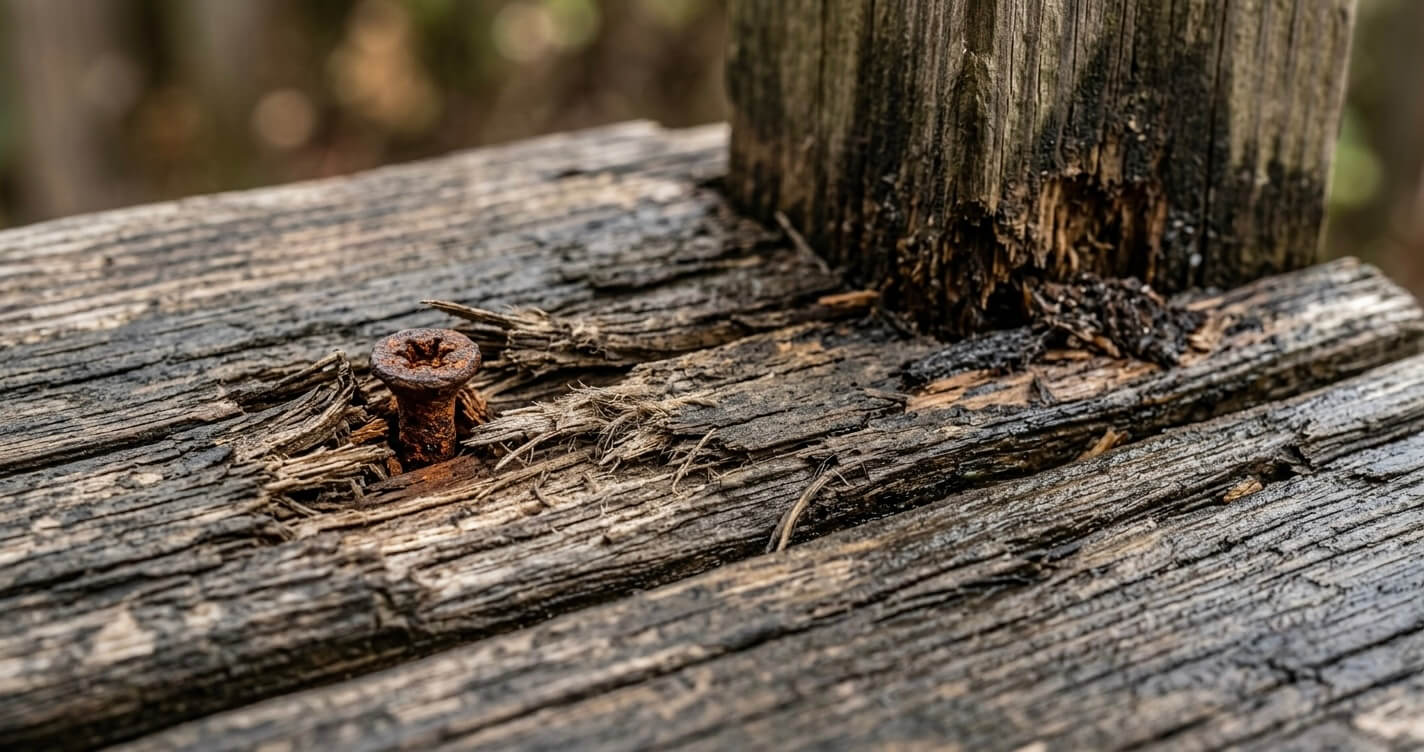

The original wood deck was roughly 18 years old and showed the classic signs of end-of-life wood decking: soft, spongy boards near the ledger board, rusted fasteners, and a railing system that no longer met current guardrail spacing standards. The homeowner’s core concern was safety, not just appearance.
Beyond the visible wear, the family had stopped using the space for anything beyond quick pass-through access to the yard. Annual staining and sealing had become a recurring maintenance chore that never fully solved the underlying wood decay. This is a familiar pattern across Northern Virginia: many homeowners keep patching an aging wood deck for years before recognizing that the framing, not just the surface boards, has reached the point of replacement rather than repair.
Design Solution – Planning the Composite Deck Addition

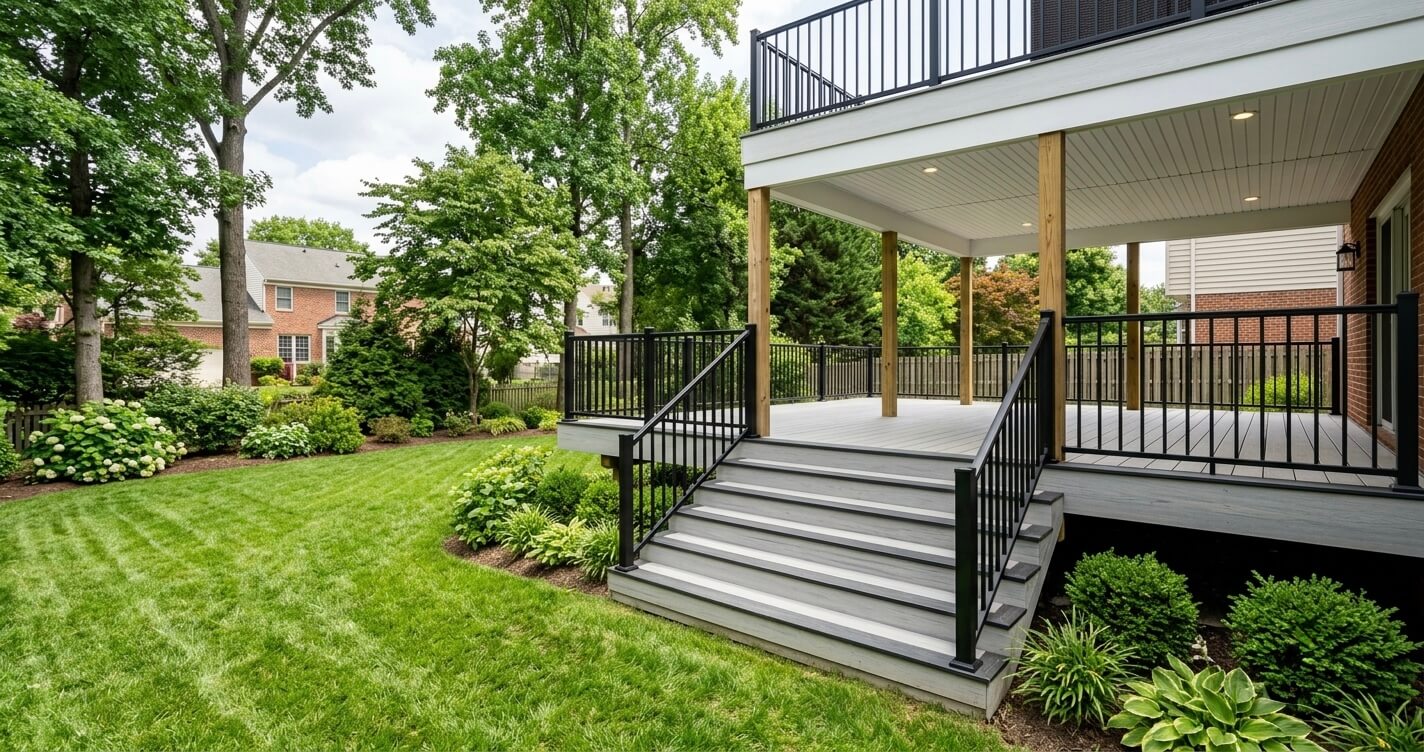

The design solution replaced the single-level wood deck with a two-tier composite deck: a larger upper level off the kitchen for dining and grilling, and a lower level with direct yard access connected by a wide stair run. Composite decking was selected specifically for its resistance to rot, warping, and the freeze-thaw cycles common in Northern Virginia winters.
Homeowners weighing a deck against other outdoor living options often ask how it compares to a screened porch or sunroom for their yard and budget. Our screen porch vs sunroom vs deck Northern Virginia comparison breaks down that decision in more depth. In this case, the homeowner had already ruled out a fully enclosed structure because the priority was direct, open-air access to the yard rather than an enclosed room.
Construction Process – From Demolition to Completion

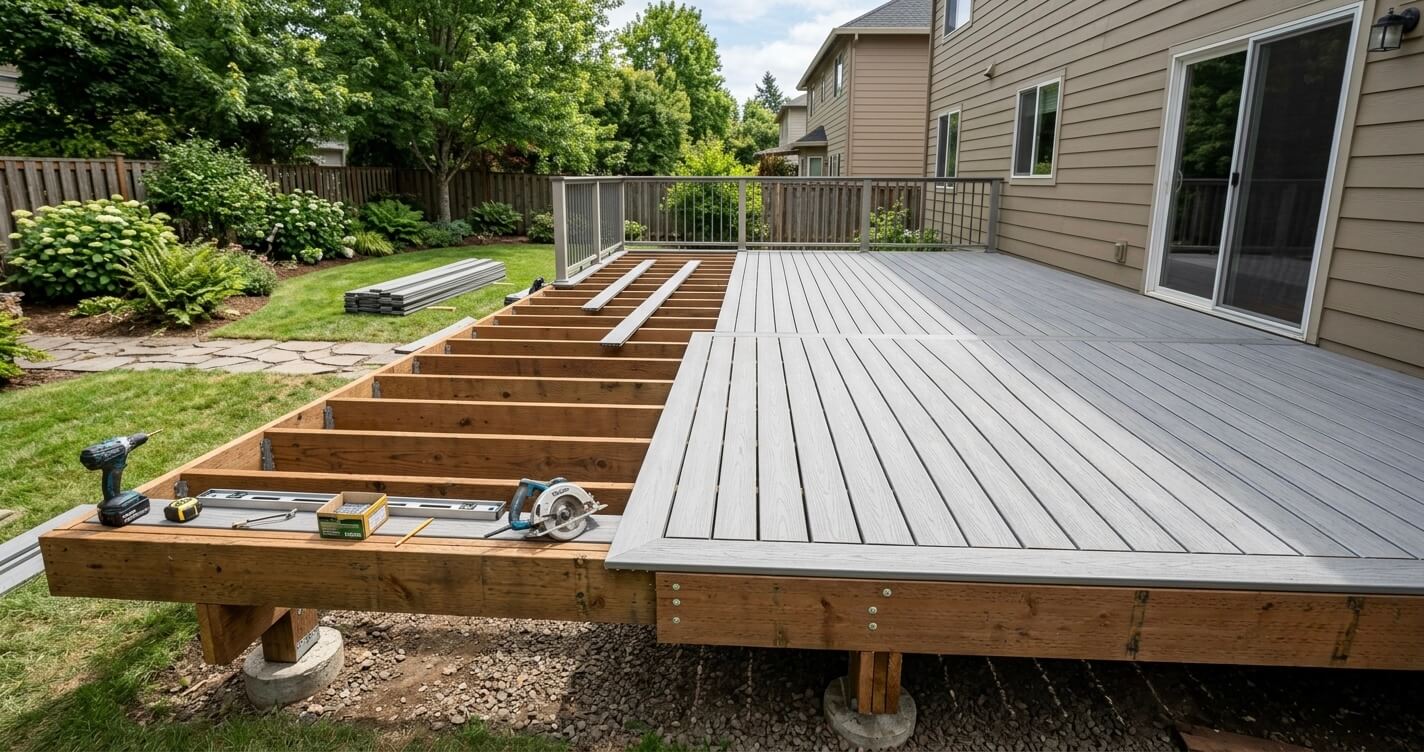

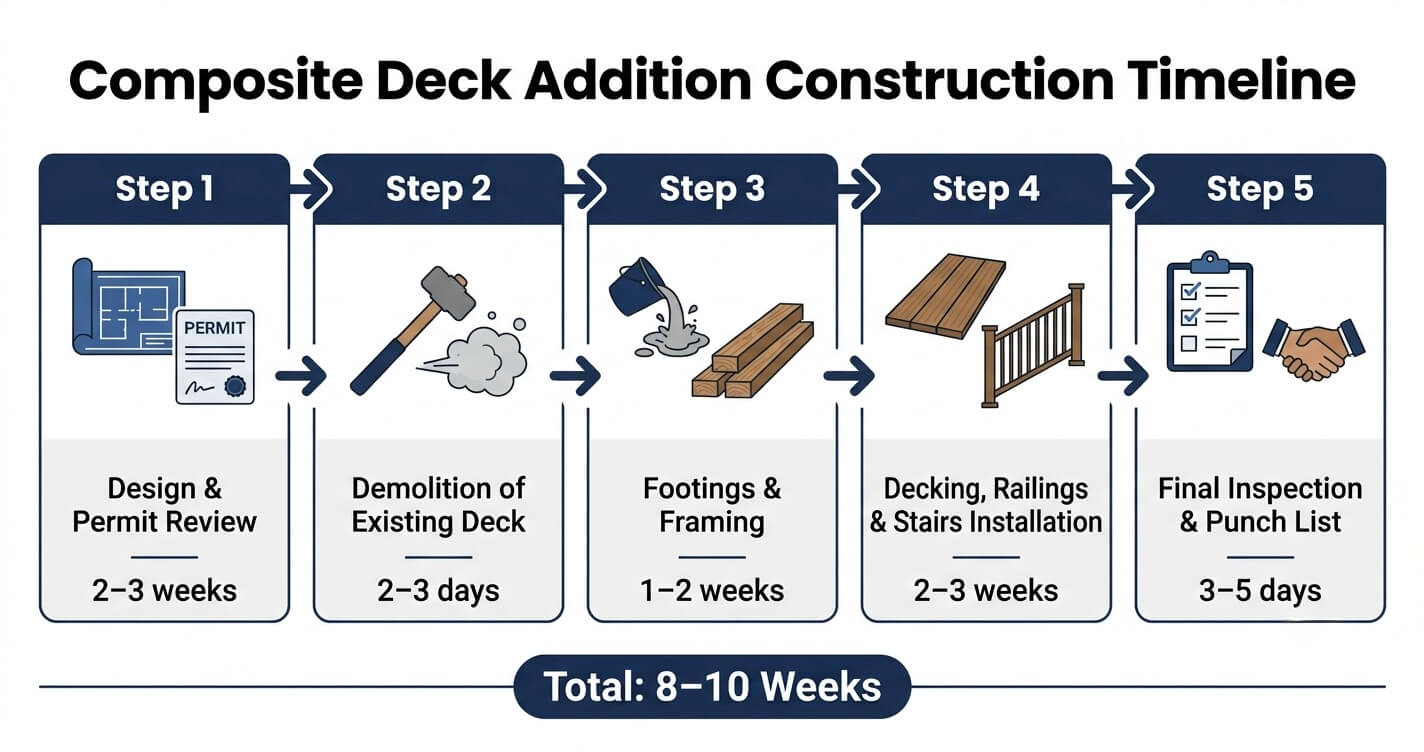

Construction moved through four phases: demolition of the old deck and footings, new footing and framing installation, composite decking and railing installation, and final inspection. The full sequence for this deck addition, including permit review time, took approximately eight to ten weeks from contract to final inspection.

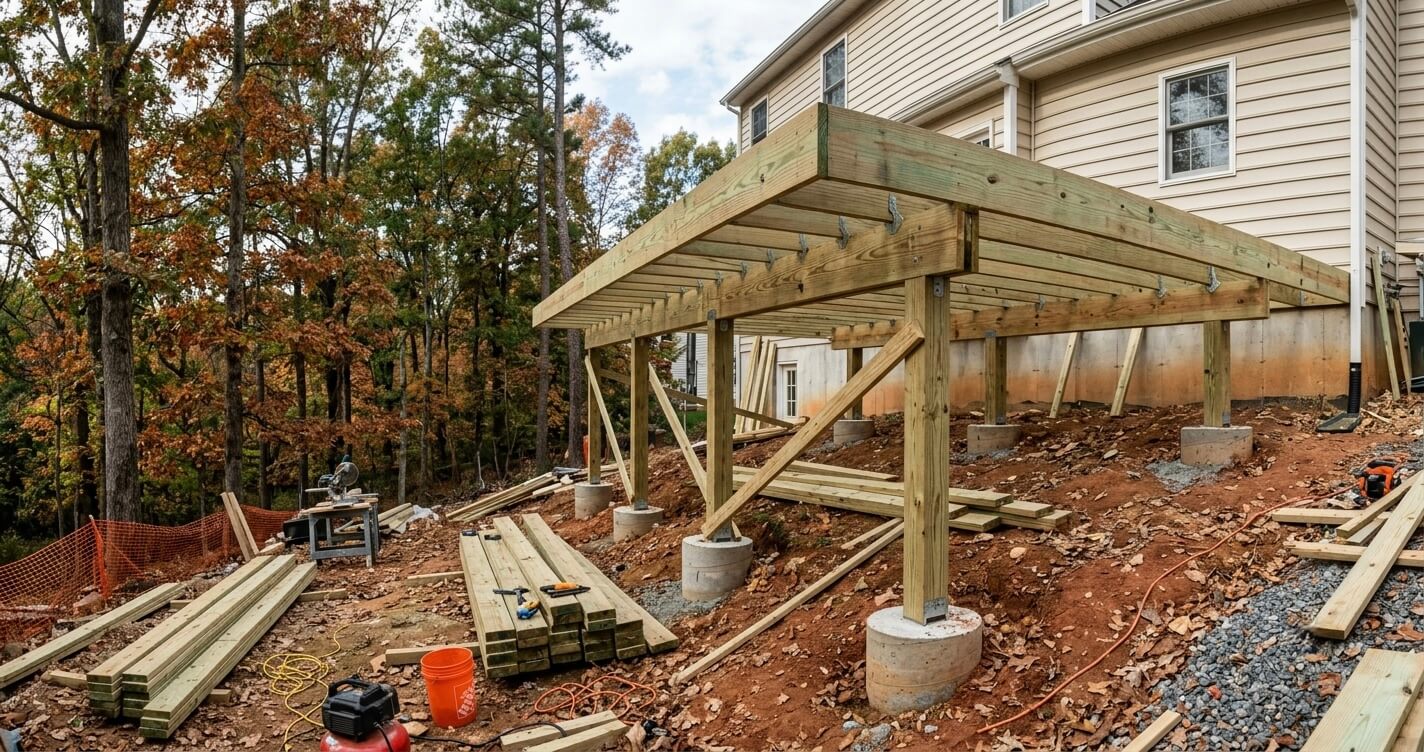

Demolition removed the old decking, joists, and footings down to grade, since the original footings did not meet the depth required for the new two-tier design. New footings were poured below Virginia’s required frost depth, followed by pressure-treated framing sized for the added load of a second tier. Composite decking boards, aluminum railings, and the new stair run were installed last, followed by a county inspection of the structural connections, guardrail heights, and stair geometry before the deck addition was approved for use.
Permit Considerations for Deck Additions in Fairfax County
A residential addition building permit is required to construct a new deck or make structural alterations to an existing deck in Fairfax County, and a separate electrical permit applies if lighting or outlets beyond low-voltage fixtures are added. Ground-level wood patios built directly on grade, without post-and-beam construction, are the one common exception.
According to Fairfax County’s Land Development Services department, homeowners must obtain a residential addition building permit for any new deck or deck alteration, and any added electrical work beyond low-voltage lighting requires a separate electrical permit; wood patios built directly on the ground without post-and-beam framing are exempt from this requirement. This distinction matters for most Vienna, VA homeowners, because even a modest elevated deck is very unlikely to qualify for the ground-level exemption and will need full permit review.
Budget Considerations – What This Deck Addition Cost

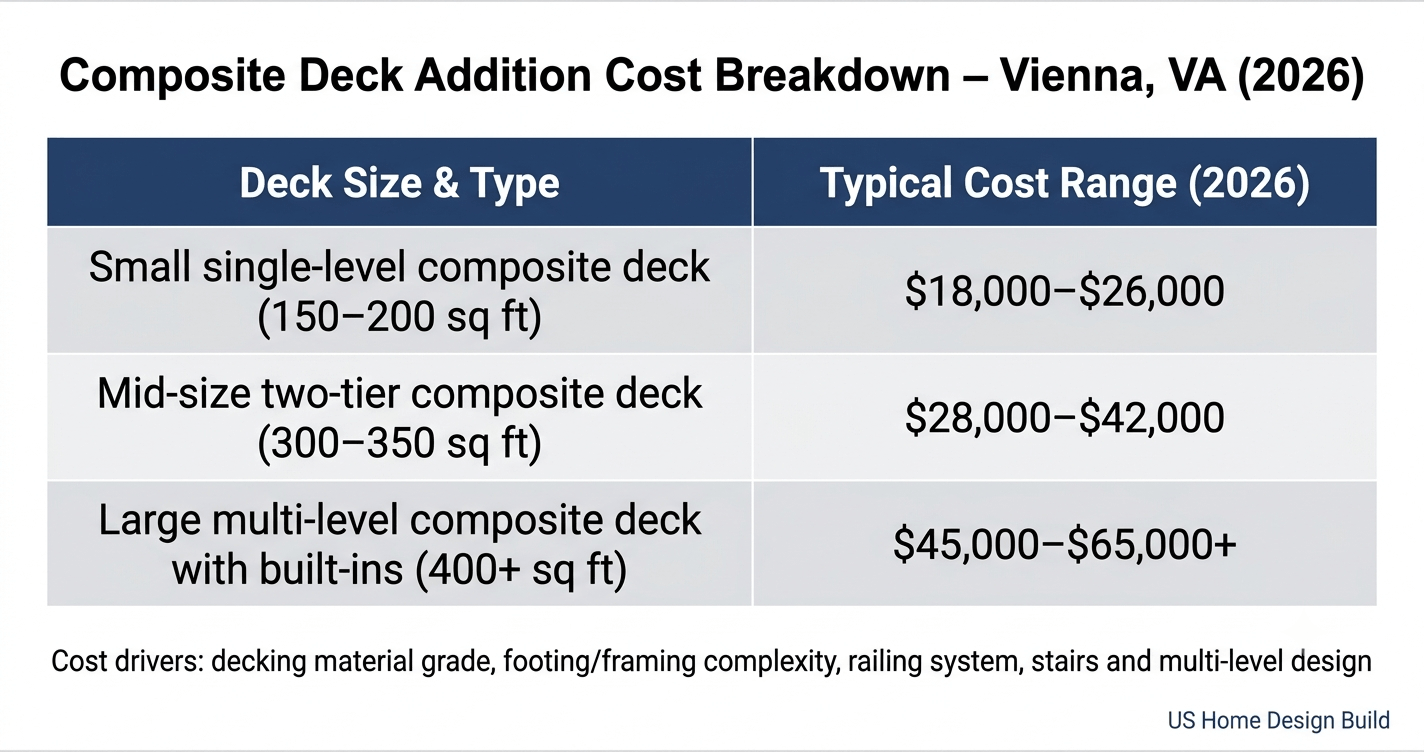

This 320-square-foot, two-tier composite deck fell within the typical Northern Virginia range of $28,000 to $42,000 in 2026, with composite decking material, footing depth requirements, and railing style being the three biggest cost drivers. Composite decking generally costs more upfront than pressure-treated wood but requires no annual staining or sealing.
Nationally, homeowners report spending an average of roughly $16,900 on a new wood deck project, according to the National Association of Realtors’ Remodeling Impact Report. Composite deck additions in Northern Virginia typically run higher than this national wood-deck average because of composite material costs and the multi-level framing common on sloped Vienna and Fairfax County lots.
Homeowners considering a similar project may benefit from discussing their options with an experienced design-build team before finalizing budgets or timelines.
Timeline – How Long the Deck Addition Took
From signed contract to final inspection, this deck addition took approximately eight to ten weeks, including roughly two to three weeks for Fairfax County permit review. Weather delays and composite material lead times are the two factors most likely to extend that window.
Design finalization and permit submission ran concurrently during the first two to three weeks. Demolition of the existing wood deck took two to three days once permits were approved. Footings and framing required one to two weeks, largely dictated by concrete cure time. Composite decking, railings, and stair installation took the remaining two to three weeks, followed by a three-to-five-day window for final inspection and any punch-list items.

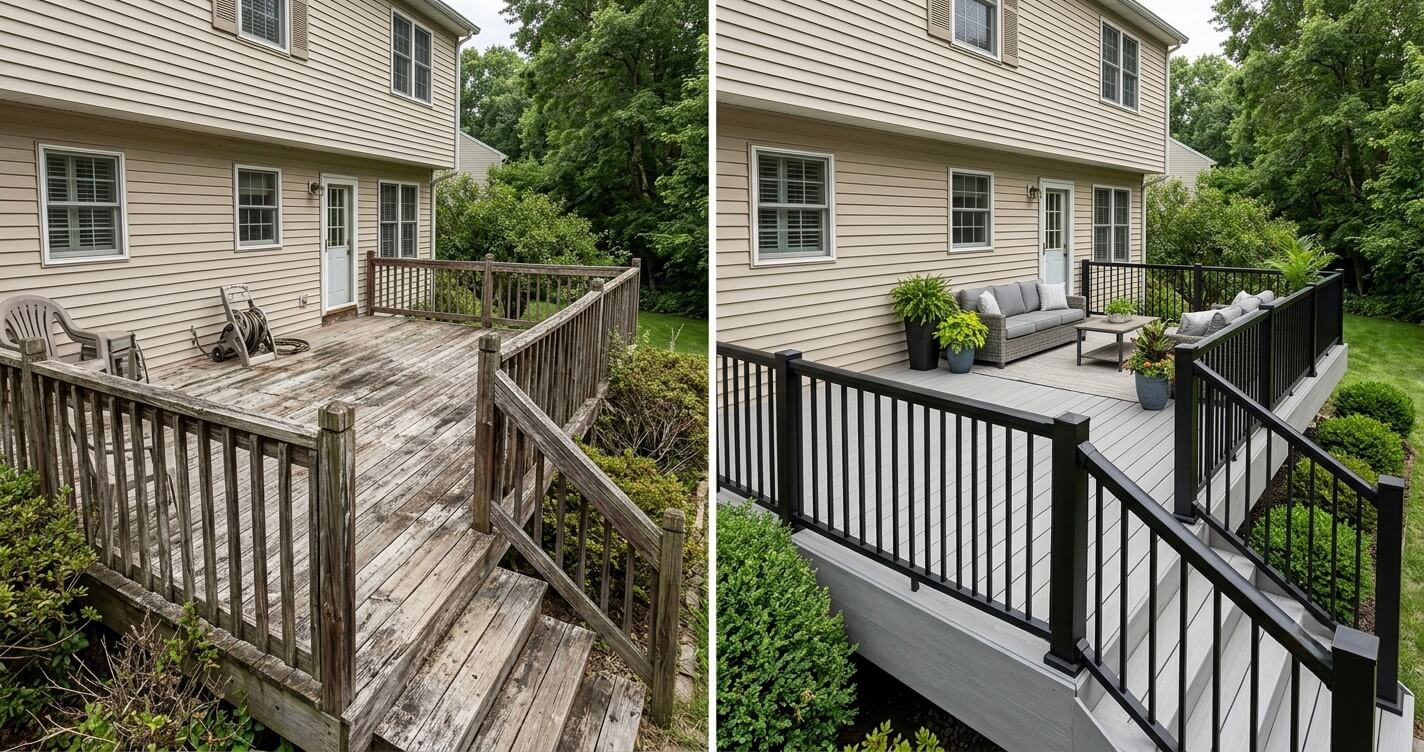

Results – Deck Addition Before and After Vienna VA

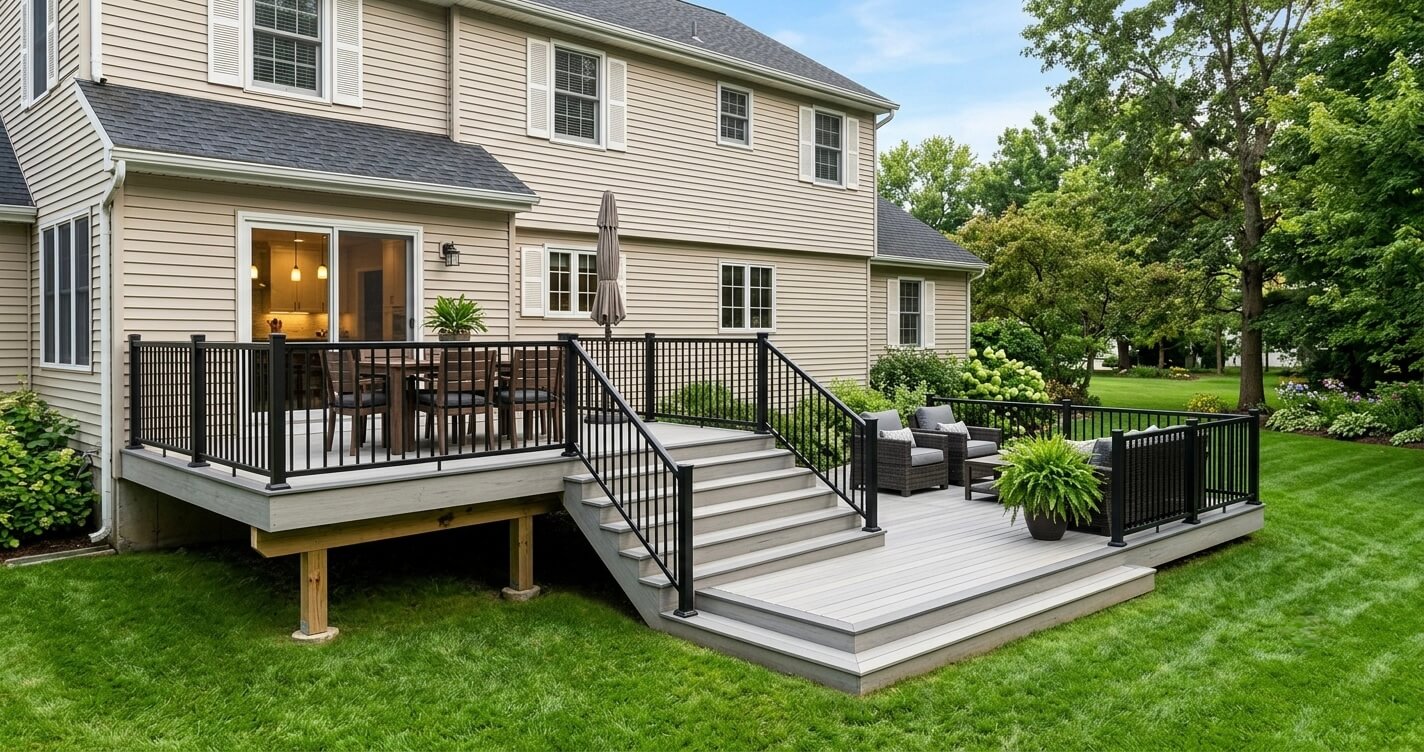

The finished composite deck gave the homeowner a safe, low-maintenance outdoor space nearly triple the usable footprint of the original deck, with a design that reads as original to the home rather than an add-on. It also positions the home more competitively at resale, since outdoor living space consistently ranks among the features buyers respond to.
Homeowners who complete a new wood deck project report a Joy Score of roughly 9.6 out of 10 upon completion, one of the highest satisfaction ratings among common outdoor remodeling projects, according to the National Association of Realtors. Composite deck additions, which trade a modestly higher material cost for near-zero annual maintenance, tend to sustain that satisfaction well beyond the first season, since owners aren’t confronting the recurring staining and sealing that erode enthusiasm for wood decks over time.
For homeowners weighing an outdoor upgrade against a larger-scale renovation, our full home renovation before and after Vienna VA case study shows what a whole-house transformation looks like in the same market.
Lessons Learned – What Vienna VA Homeowners Should Know
The clearest lesson from this deck addition is that replacing a failing wood deck with composite decking is rarely just a cosmetic upgrade, footings, framing, and code compliance usually need to be addressed at the same time. Homeowners who plan for that full scope upfront avoid budget surprises mid-project.
Three takeaways stood out from this project. First, an old deck’s framing condition, not just the surface boards, determines whether repair or full replacement makes sense. Second, composite decking’s higher material cost is easiest to justify when weighed against 10 to 15 years of avoided staining and sealing, not just the sticker price on day one. Third, sloped Northern Virginia lots often require engineering adjustments that a flat-lot deck design simply doesn’t need, which is worth confirming during the design phase rather than after footings are poured.
This pattern shows up across other exterior projects too. Our second story addition case study in McLean, VA documents a similar case where addressing the structural fundamentals early kept the project on budget.
Frequently Asked Questions
How much does a composite deck cost in Vienna, VA?
A composite deck in Vienna, VA typically costs between $28,000 and $42,000 for a mid-size, multi-level design in 2026. Material grade, framing complexity on sloped lots, and railing choice are the main variables that move a project toward the higher or lower end of that range.
Do I need a permit for a deck addition in Fairfax County?
Yes. Fairfax County requires a residential addition building permit for any new deck or structural alteration to an existing deck. A separate electrical permit is needed if the project adds outlets or lighting beyond low-voltage fixtures.
How long does a deck addition take to build?
Most composite deck additions in Northern Virginia take eight to ten weeks from contract to final inspection. Permit review typically accounts for two to three weeks of that timeline, with the remainder covering demolition, framing, and installation.
Is composite decking worth the extra cost over wood?
For most Northern Virginia homeowners, yes. Composite decking costs more upfront but eliminates the annual staining and sealing that wood decking requires, and over a 10 to 15 year ownership period the reduced maintenance often offsets the higher initial material cost.
Can an old wood deck be replaced with composite decking on the same footprint?
Yes, in most cases, though the existing footings and framing still need to be inspected and typically upgraded to meet current code. Reusing the same footprint can simplify permit review, but it doesn’t eliminate the need for new footings if the originals don’t meet current frost-depth and load requirements.
What’s the return on investment for a deck addition in Northern Virginia?
Deck additions are consistently among the higher-satisfaction outdoor projects homeowners complete, with a reported Joy Score of about 9.6 out of 10. Beyond personal satisfaction, well-built decks are also a feature buyers actively look for, which supports resale value in competitive Northern Virginia neighborhoods.
Does US Home Design Build build decks in Vienna, VA?
Yes. Our deck builder Vienna VA design-build services are available for homeowners throughout Vienna and the rest of Northern Virginia, including Fairfax County, McLean, and Reston.
Final Thoughts
This deck addition before and after Vienna VA case study reflects a project pattern we see across Northern Virginia: an aging wood deck that has quietly become a safety and maintenance liability, replaced with a composite structure built for the way the family actually wants to use their backyard.
Planning a similar deck addition in Vienna, VA or elsewhere in Northern Virginia? Contact US Home Design Build to discuss your goals, budget, and timeline with our team.
