A roof replacement before and after McLean VA project rarely shows up in listing photos the way homeowners expect, the real story is the leak that forced the decision, the decking damage found mid tear-off, and the dollar-for-dollar return once the job is finished. This case study follows a 1994 Colonial in McLean, VA, from a 27-year-old, granule-worn asphalt shingle roof to a fully replaced architectural shingle system, covering the homeowner’s challenge, the material decisions, the Fairfax County permit process, the itemized cost, and the projected resale return.
US Home Design Build has served Northern Virginia homeowners for years, managing roofing, siding, additions, and full home renovations from the first inspection through final county sign-off, and this project follows the same design-build process used on every roofing job the company completes across McLean, Vienna, Fairfax, and Great Falls.
Project Overview

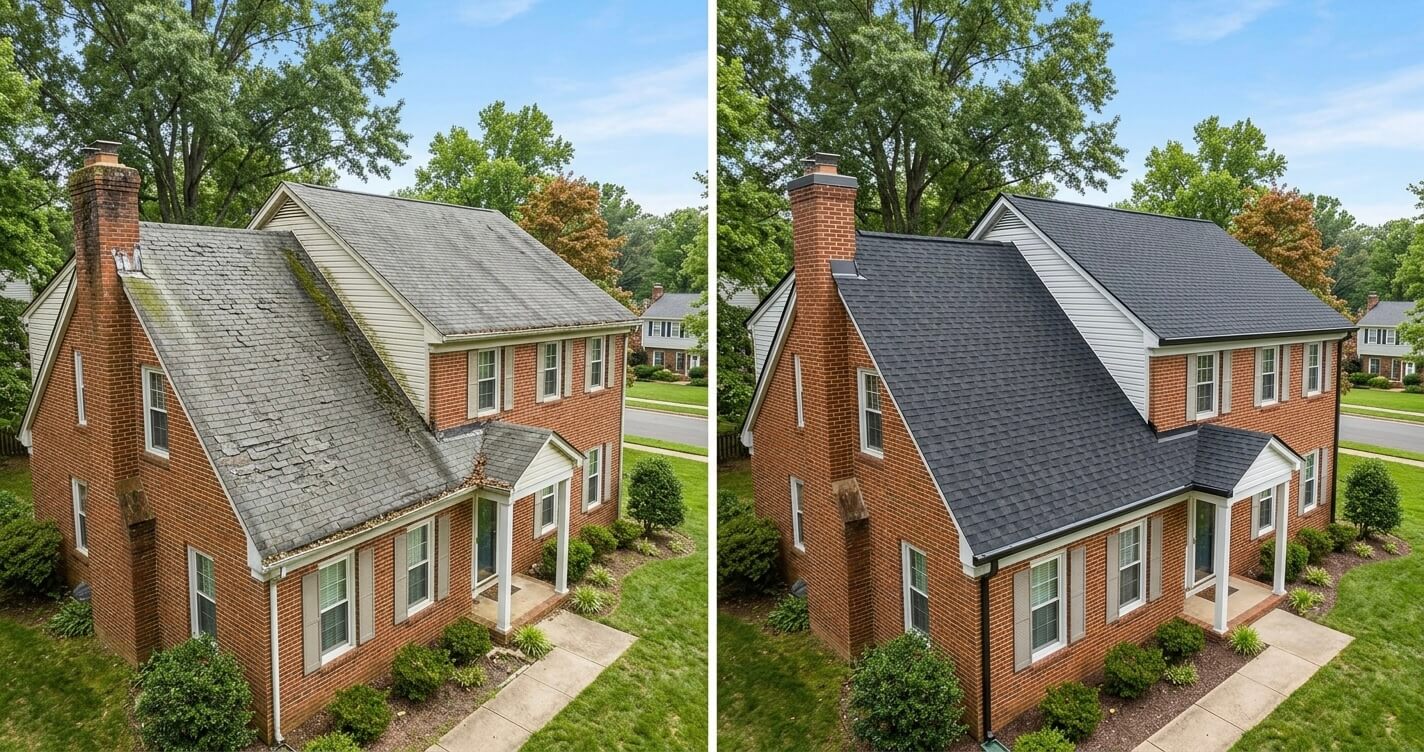

This roof replacement before and after McLean VA case study covers a 1994 Colonial-style home with approximately 2,800 square feet of roof area (28 roofing squares), where the original three-tab asphalt shingle roof was fully torn off and replaced with architectural laminate shingles over a three-week project in spring 2026.
The home sits on a wooded half-acre lot in McLean, VA, and features a moderate 6:12 roof pitch with two dormers, three valleys, and an attached two-car garage roofline tying into the main structure. The Whitfield family purchased the home in 2011 and plans to remain in it long-term, but wanted the roof addressed proactively rather than waiting for a full failure. The original shingles were installed in 1998, following an earlier wind-damage re-roof, making the roof system 27 years old by the time replacement began in 2026, several years past the typical service window for standard three-tab asphalt shingles.
The Homeowner’s Challenge (Before Condition)

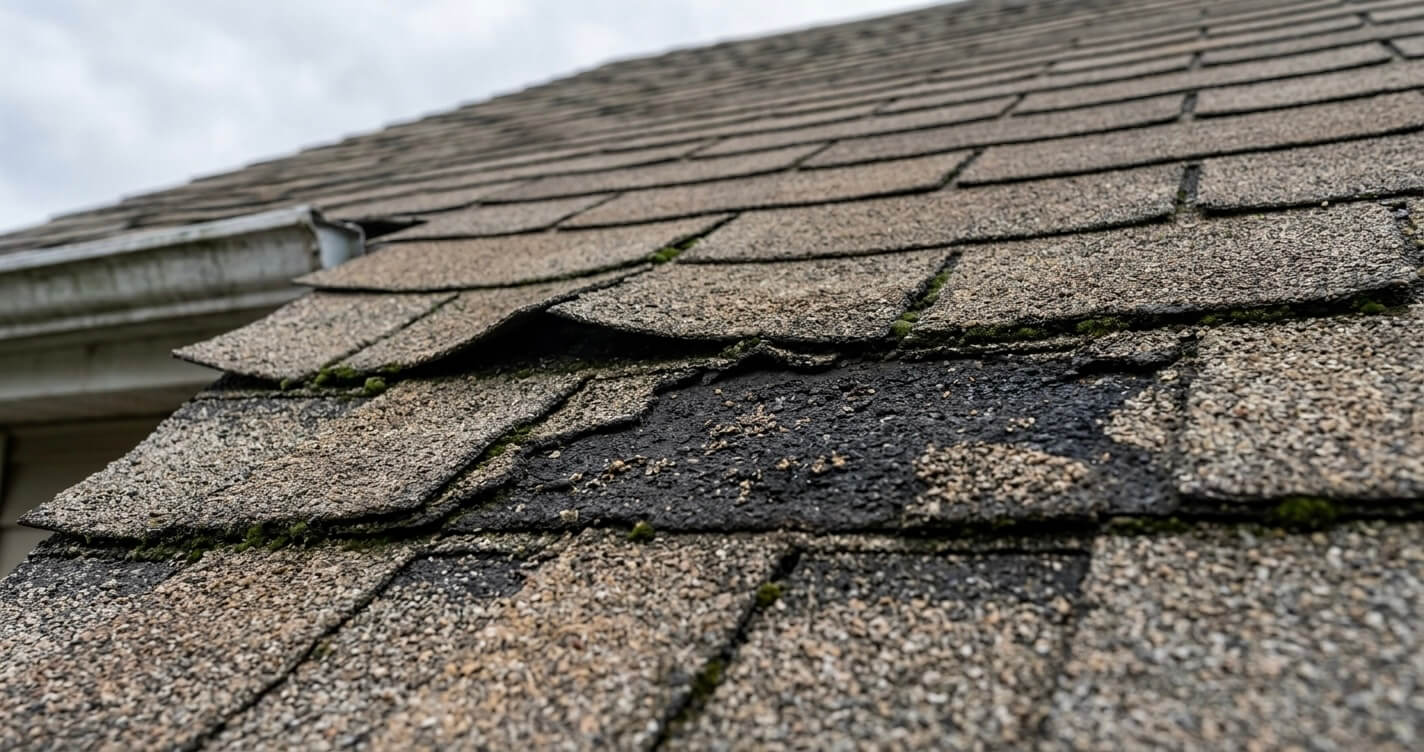

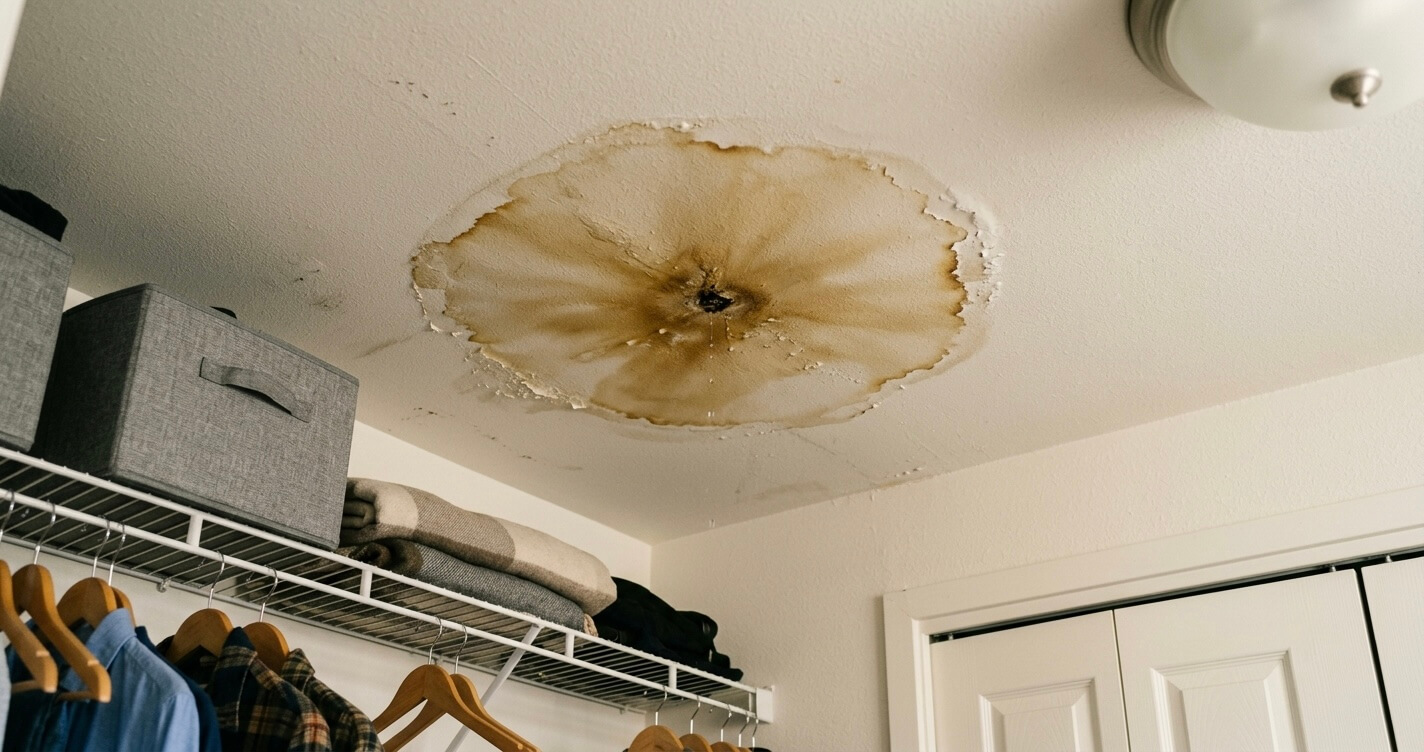

The Whitfields’ original roof was 27 years old, well past the typical 20–25 year service life of standard three-tab asphalt shingles, and a March 2026 storm caused an active leak that stained the ceiling inside an upstairs bedroom closet.
Before the storm, the warning signs were already visible but easy to overlook from ground level. Granules had been collecting in the gutters for at least two seasons, a sign that the protective mineral coating on the shingles was wearing away. On the south-facing slope, which received the most direct sun exposure, shingles had begun to curl and cup at the edges. The north-facing slope showed dark algae and moss streaking along the shaded sections near the chimney. Near one of the roof valleys, several shingles were missing entirely after a earlier windstorm, and a soft, slightly spongy spot had developed in the decking beneath a dormer, a sign of long-term moisture intrusion rather than a single storm event.
Fairfax County’s housing stock adds important context to why this pattern is so common across McLean. The median construction year for homes across Fairfax County is 1983, which means a large share of the county’s single-family housing stock is now carrying original or once-replaced roofing systems that are well beyond a typical 20–30 year asphalt shingle lifespan. This aging-inventory pattern is one of the main reasons roof replacement remains one of the most frequently needed exterior projects across McLean, Vienna, and the wider Fairfax County market.
Homeowners considering a similar project may benefit from discussing their roof’s age and visible wear with an experienced design-build team before a small leak becomes a larger structural repair.
Design & Material Solution
The Whitfields selected architectural laminate shingles in a driftwood charcoal tone, which typically last 25–30 years, along with upgraded synthetic underlayment, ice-and-water shield in the valleys and eaves, and improved ridge ventilation.
Architectural (dimensional) shingles were chosen over a like-for-like three-tab replacement because they offer significantly stronger wind resistance, a heavier profile that better matches the Colonial architecture common throughout McLean, and a longer expected service life. The project also included new aluminum step flashing around the chimney and dormers, a new drip edge and gutter apron, and a continuous ridge vent to improve attic airflow, an upgrade the original 1998 roof did not have.
Metal roofing was discussed during the design phase but ultimately ruled out for this project. Metal systems can last 40–70 years but typically return a lower percentage of cost at resale compared with asphalt shingles, and the higher upfront cost did not align with the Whitfields’ 5–10 year ownership horizon. For homeowners weighing that same decision, US Home Design Build’s Asphalt Shingles vs Metal Roofing in Northern Virginia guide breaks down the lifecycle cost, resale value, and climate performance differences in more detail.
This project used the company’s asphalt shingle roofing services, which cover installation, full replacement, and repair for steep-slope residential roofs throughout Northern Virginia. For homeowners with flat or low-slope sections, common on additions, porches, or garages with a different roofline, US Home Design Build’s TPO roofing contractors provide a durable, energy-efficient membrane alternative that is not suited to steep-slope Colonial rooflines like this one but is common on flat-roofed additions in the same neighborhoods.
Construction Process (Tear-Off to Final Inspection)
The roof replacement was completed in four working days, covering full tear-off, decking inspection and repair, underlayment installation, shingle application, and a final cleanup sweep for nails and debris.
Day-by-day sequence:

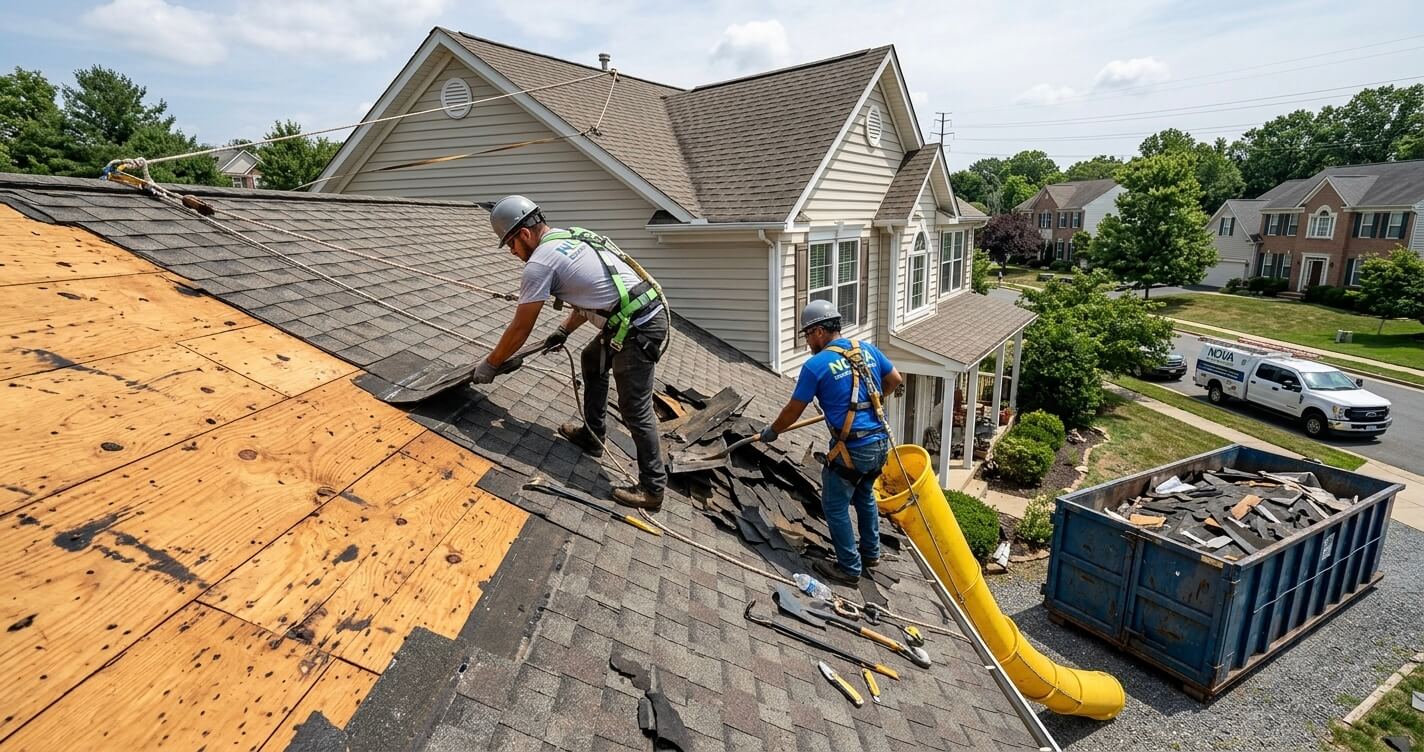

- Day 1: Full tear-off of the existing three-tab shingles and old underlayment down to the roof decking, with disposal hauled off-site the same day.
- Day 1–2: Decking inspection. Four sheets of plywood decking were replaced near the valley where the soft spot had developed, confirming the moisture intrusion the homeowners had suspected.

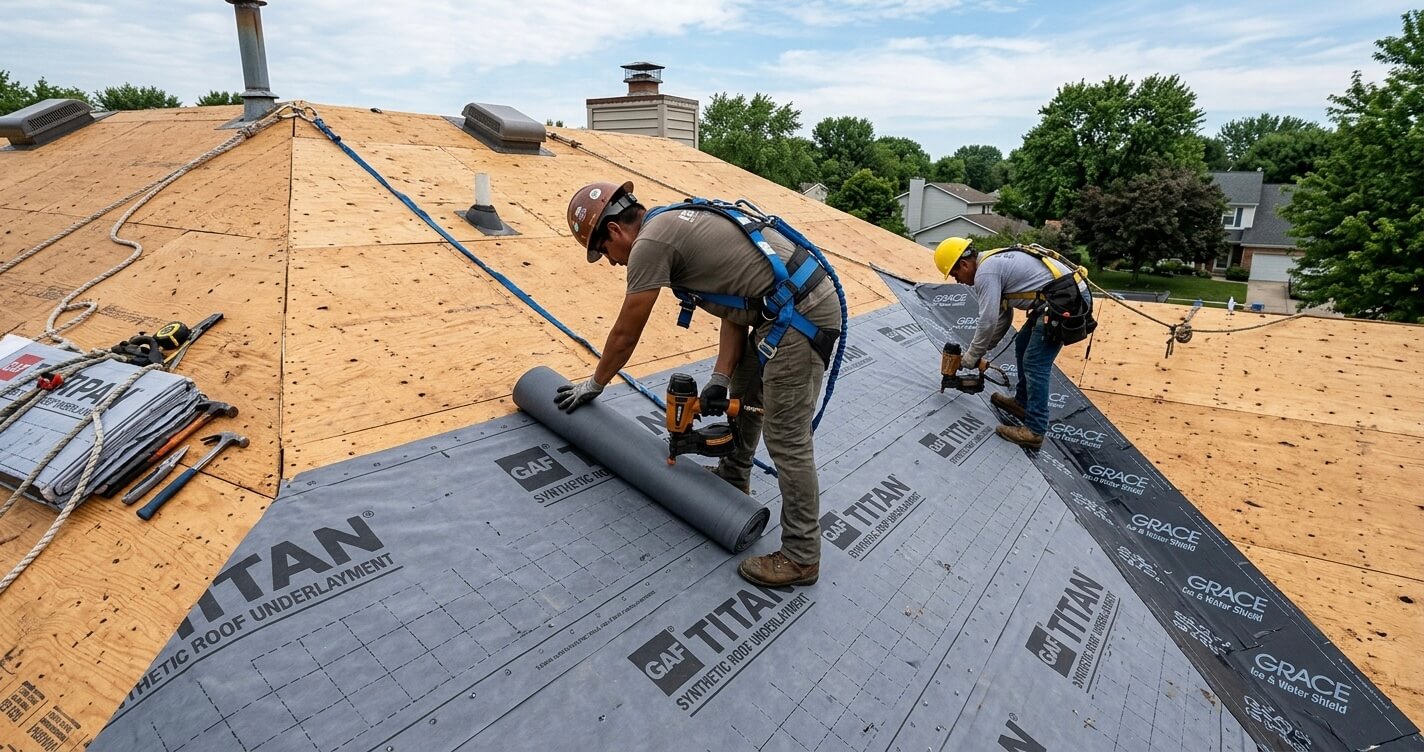

- Day 2: Installation of synthetic underlayment across the full roof, with ice-and-water shield applied in all valleys, along the eaves, and around penetrations.
- Day 2–3: New aluminum flashing installed around the chimney and dormers, followed by architectural shingle installation starting at the eaves and working toward the ridge.
- Day 3–4: Ridge vent installation, final flashing details, gutter apron installation, and a full magnetic nail sweep of the yard and driveway.
- Day 4: Homeowner walkthrough and photo documentation, followed by scheduling of the Fairfax County final inspection.
Homeowners planning a similar project should ask their contractor how decking damage is priced before work begins, unexpected repairs are common on roofs over 20 years old and are far easier to budget for in advance than to negotiate mid-project.
Budget & Cost Breakdown

This roof replacement in McLean VA totaled $24,150, covering tear-off and disposal, decking repair, underlayment, architectural shingles, ventilation upgrades, and Fairfax County permit fees, within the typical $18,000–$30,000 range for a comparable 28-square roof in this market.
This cost sits toward the upper-middle of typical Northern Virginia pricing due to the home’s roof complexity, three valleys, two dormers, and a garage tie-in all add labor time compared with a simple rectangular roof plan. McLean’s premium labor market and material costs also run above the broader Northern Virginia average, consistent with pricing patterns already documented across the region.

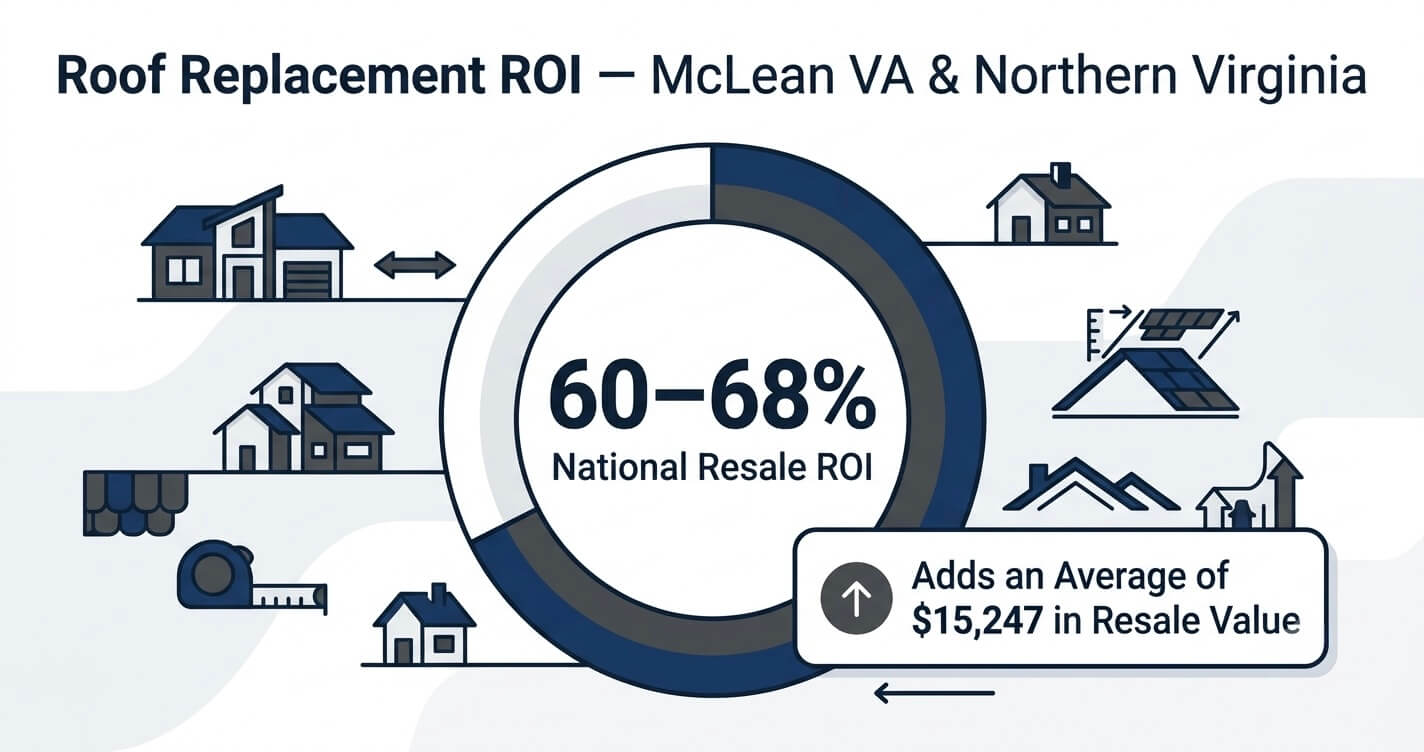

The resale math behind this investment is well documented at the national level. A new asphalt shingle roof adds an average of $15,247 to a home’s resale value, with a national return-on-investment range of 60–68% of total project cost recouped at the point of sale. Applied to this project’s $24,150 cost, that national range translates to roughly $14,500–$16,400 in resale value, plus the harder-to-quantify benefit of removing one of the most common home inspection objections buyers raise.
For a full comparison of roofing ROI against other exterior and interior projects, see US Home Design Build’s Best ROI Home Improvements Northern Virginia 2026 guide, which ranks roofing alongside kitchens, bathrooms, additions, and ADUs by resale return.
Timeline

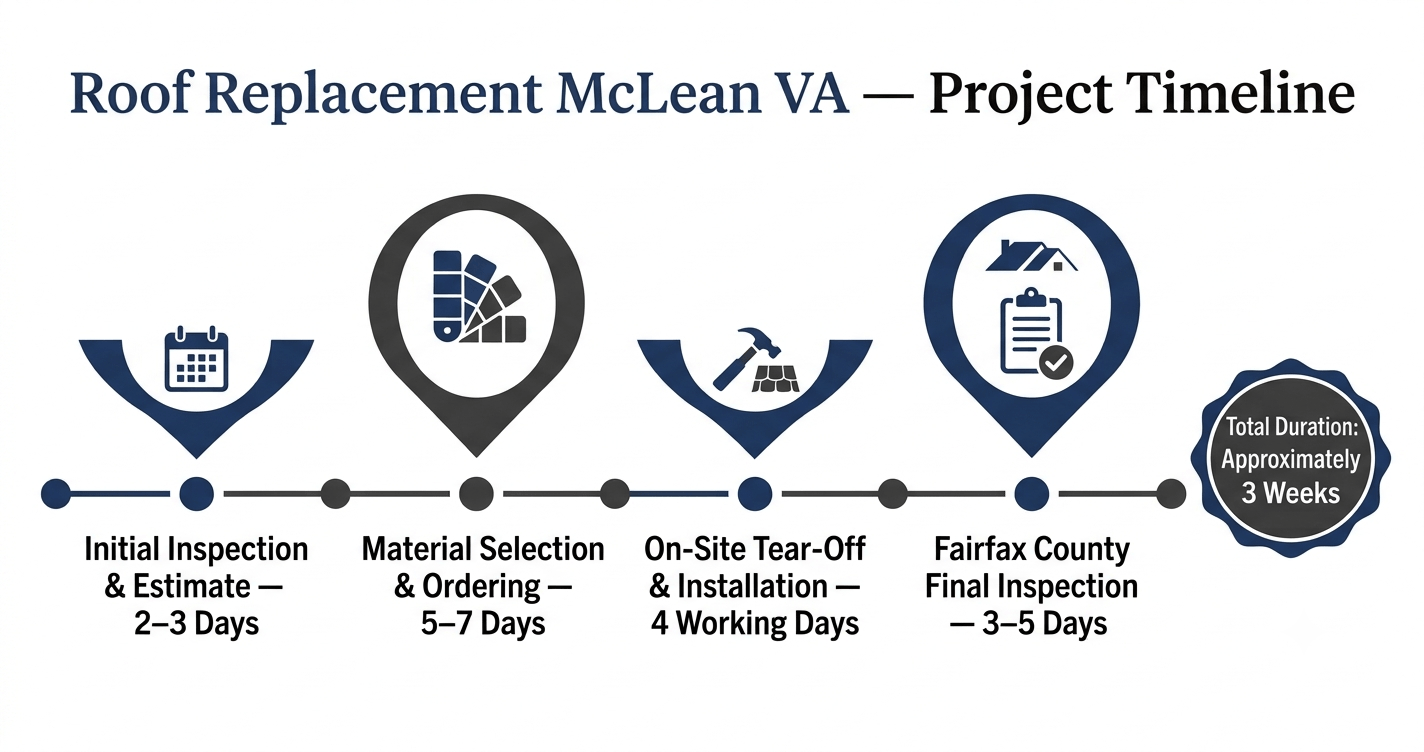

From initial inspection to final walkthrough, this project took approximately three weeks, including one week for estimating and material ordering, four days of on-site installation, and a final inspection scheduled the following week.
Permit Considerations in Fairfax County
Yes, a Fairfax County building permit was required for this project because it involved a full tear-off rather than a shingle-over layover, and the completed work passed final inspection under the 2021 Virginia Uniform Statewide Building Code.
Fairfax County requires a permit for most full roof replacements, particularly when the existing roofing material is removed down to the decking, decking repairs are made, or the scope affects structural sheathing. The permit application was submitted through the county’s PLUS portal, and a final inspection was scheduled after installation to confirm proper flashing, underlayment, ventilation, and shingle installation before the project was formally closed out.
For a complete breakdown of how Fairfax County permitting works across project types, including what triggers a permit, typical review timelines, and how the PLUS portal process works, see US Home Design Build’s Remodeling Permit Fairfax County guide.
Results (After Condition & ROI)

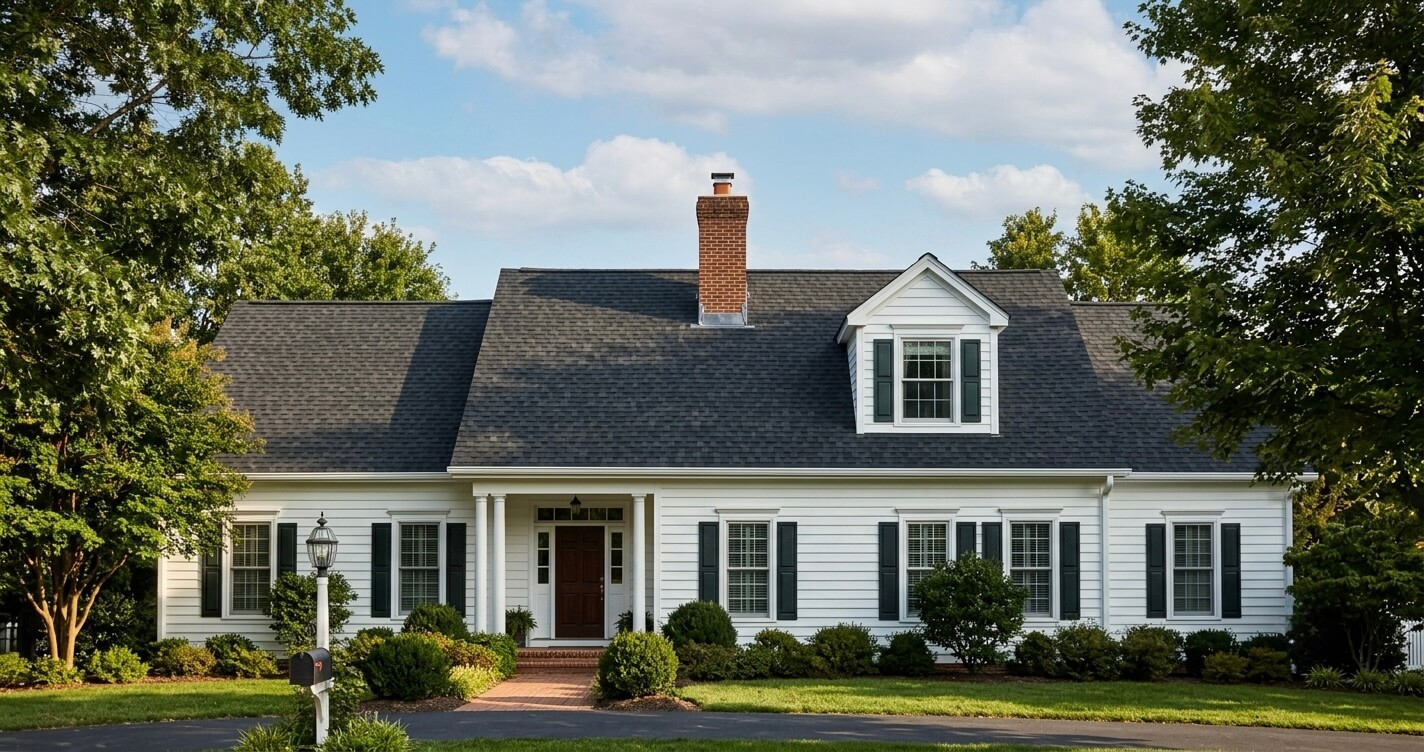

The completed roof eliminated the active leak, added a clean, uniform charcoal roofline to the home’s curb appeal, and is projected to return 60–68% of its cost at resale based on national roofing ROI data.
The most immediate result was structural: the leak into the bedroom closet stopped completely, and the replaced decking removed the moisture concern that had been developing under the dormer for an unknown period of time. Visually, the new architectural shingles gave the home a heavier, more dimensional roofline compared with the flat appearance of the original three-tab shingles, which the Whitfields noted made the entire front elevation look more updated without touching the siding or windows.
The upgraded ridge ventilation also delivers a measurable efficiency benefit. Cool-roof and properly ventilated attic systems reduce the amount of solar heat absorbed into the attic space, which in turn lowers the cooling load a home’s HVAC system has to work against during peak summer months. While this project used standard architectural shingles rather than a certified reflective product, the improved ridge-to-soffit airflow alone is expected to reduce peak attic temperatures compared with the home’s prior, poorly ventilated system.
“We’d been putting off the roof for two years because it wasn’t leaking yet,” Mrs. Whitfield said after the walkthrough. “Once we saw the ceiling stain, we realized waiting had already cost us, the decking damage wouldn’t have happened if we’d replaced it a year earlier.”
Lessons Learned
The clearest lesson from this project is that replacing a roof before visible failure, rather than after interior leak damage appears, preserves budget and avoids emergency-rate pricing.
- Granule loss in gutters and curling shingles are early warning signs that typically appear one to two years before an active leak develops.
- Decking damage is common on roofs over 20 years old and should be budgeted as a contingency rather than assumed away in an initial estimate.
- Upgrading ventilation at the same time as shingle replacement is significantly more cost-effective than addressing it as a separate project later.
- A full tear-off, rather than a shingle-over layover, allows the decking to be properly inspected and typically produces a longer-lasting result.
Frequently Asked Questions
How much does a roof replacement cost in McLean VA?
A full roof replacement in McLean VA typically costs between $18,000 and $30,000 for a standard 25–30 square roof, depending on roof complexity, decking condition, and shingle material. This case study’s 28-square roof with three valleys and two dormers totaled $24,150, including tear-off; decking repair, underlayment, architectural shingles, and permit fees.
How long does a roof replacement take?
A typical roof replacement in Northern Virginia takes four to seven working days on-site, though the full project timeline, including estimating, material ordering, and final inspection, usually spans two to three weeks. This case study’s installation was completed in four working days, with a total project duration of approximately three weeks.
Do I need a permit to replace my roof in Fairfax County?
Yes, Fairfax County generally requires a building permit for a full roof tear-off and replacement, particularly when decking is exposed or repaired. Permits are submitted through the county’s PLUS portal and require a final inspection before the project is closed out, following the 2021 Virginia Uniform Statewide Building Code.
What is the ROI on a roof replacement in Northern Virginia?
A new asphalt shingle roof returns approximately 60–68% of its cost at resale nationally, adding an average of $15,247 in resale value according to Opendoor’s roofing resale research. In Northern Virginia’s premium housing markets like McLean, the absolute dollar value recovered is often higher than the national average due to elevated home prices.
How do I know if I need a roof repair or a full replacement?
A roof typically needs full replacement rather than a spot repair when granule loss, curling, or missing shingles are spread across multiple roof planes, when the roof is over 20 years old, or when decking damage is discovered during inspection. Isolated damage to a single small area, on a roof under 15 years old, is often a candidate for repair instead.
What roofing material lasts longest in Northern Virginia’s climate?
Metal roofing typically lasts 40–70 years, roughly double the 20–30 year lifespan of architectural asphalt shingles, but comes with a higher upfront cost and a lower percentage ROI at resale. For most McLean and Northern Virginia homeowners planning to stay 5–10 years, architectural asphalt shingles offer the strongest balance of upfront cost, appearance, and resale return.
Will a new roof lower my homeowners insurance in Virginia?
In many cases, yes, insurers frequently offer reduced premiums for roofs under 10 years old or those built with impact-resistant materials, since a newer roof lowers the insurer’s risk of storm and water-damage claims. Homeowners should confirm specific discount eligibility directly with their insurance provider after a roof replacement is completed and permitted.
Should You Replace Your Roof Before Selling or Staying Long-Term?
If you plan to sell within three years, a roof replacement is one of the strongest exterior ROI projects available; if you’re staying long-term; it protects the home’s structure and can modestly reduce cooling costs.
For sellers, a recently replaced roof removes one of the most common negotiation points buyers raise during a home inspection, and the national 60–68% resale return makes it one of the more reliable exterior investments compared with lower-return interior remodels. For long-term owners like the Whitfields, the calculation shifts toward protecting the structure, avoiding water damage to insulation and framing, and capturing modest energy savings from improved ventilation over the life of the roof.
Homeowners weighing whether to invest in a roof replacement versus other renovation priorities, or whether to renovate at all versus selling and moving, can review US Home Design Build’s Renovate vs Sell Northern Virginia guide for a broader decision framework specific to McLean, Fairfax, Vienna, and the wider Northern Virginia housing market.
This case study is part of a growing library of real project documentation from US Home Design Build. For a comparable structural project in the same city, see the Second Story Addition McLean VA: 2026 Case Study, which follows a similar before-and-after format for a vertical home expansion.
Planning a similar roof replacement in McLean or elsewhere in Northern Virginia? Contact US Home Design Build to discuss your roof’s condition, timeline, and budget with our design-build team.
